In 2004, a new family roller coaster opened in Adventure land, located next to the corporate hospitality marquee and manufactured by the German company; Maurer Söhne.

h

An advertisement for the new attraction located on the fence.

h

Another advertisement giving away hints to the general public about the theming.

h

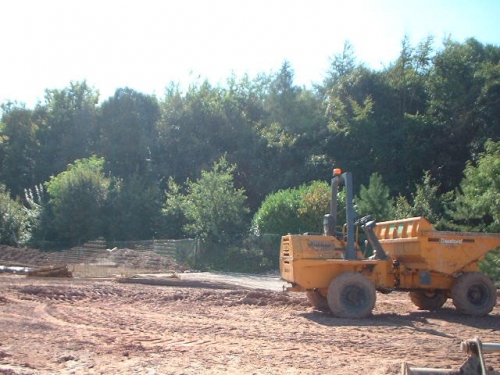

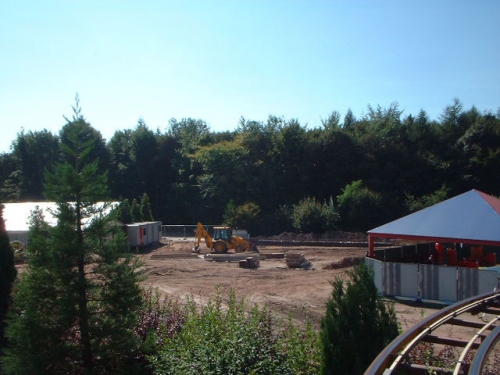

A view of the construction fence, now taking up a large area in adventure land.

h

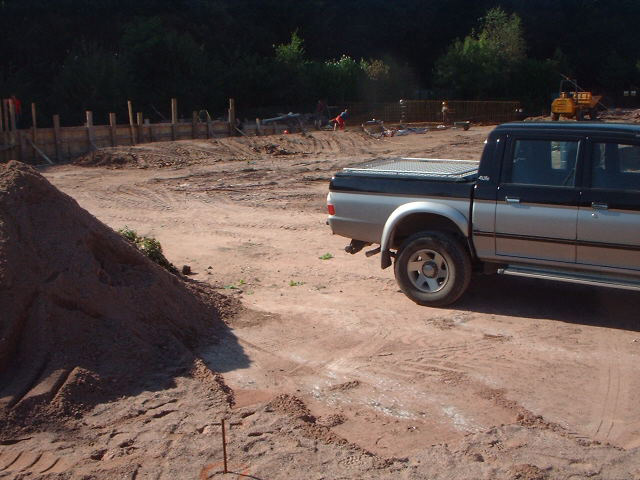

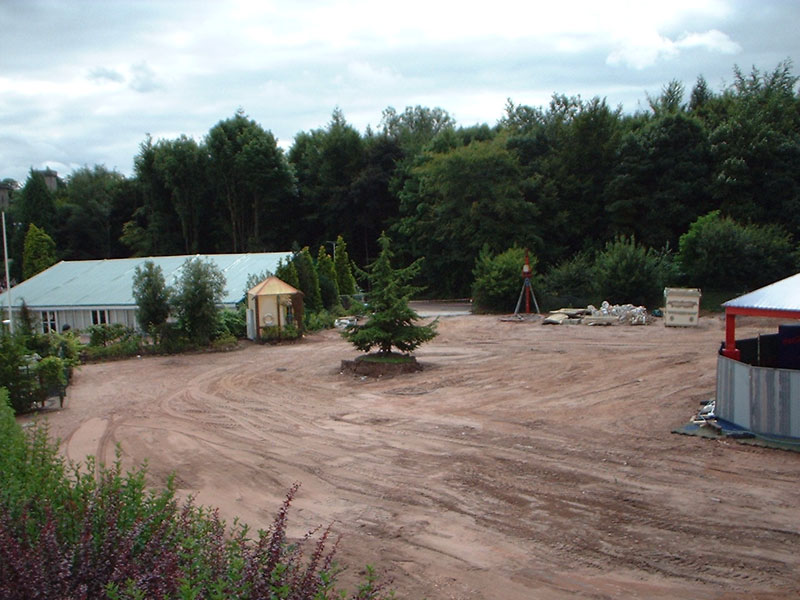

Taken from Squirrel Nutty – a significant amount of clearance has taken place.

h

You can see how close to the hospitality marquee the new coaster will be.

h

These photographs look over the fence from Squirrel Nutty.

h

New poster added to construction fence featuring an illustration of the trains and theming.

h

No view holes in this fence, which is a surprise since Alton are being so open about this coaster.

h

The same poster as the one found on the construction fence, found at the main entrance gate.

h

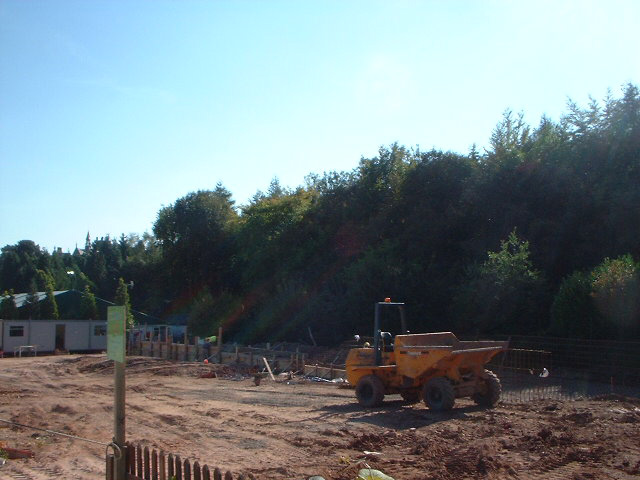

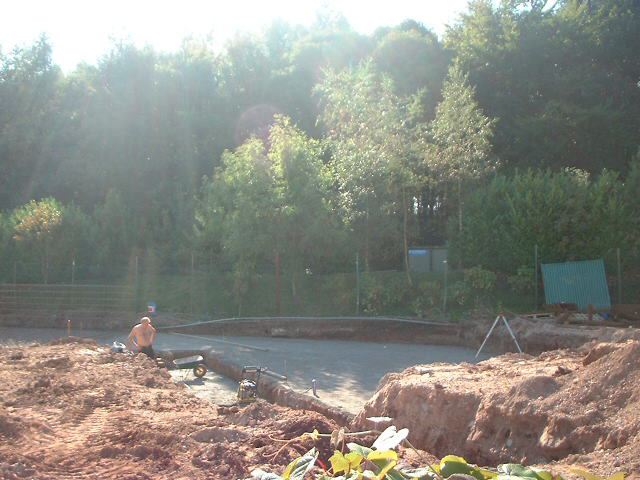

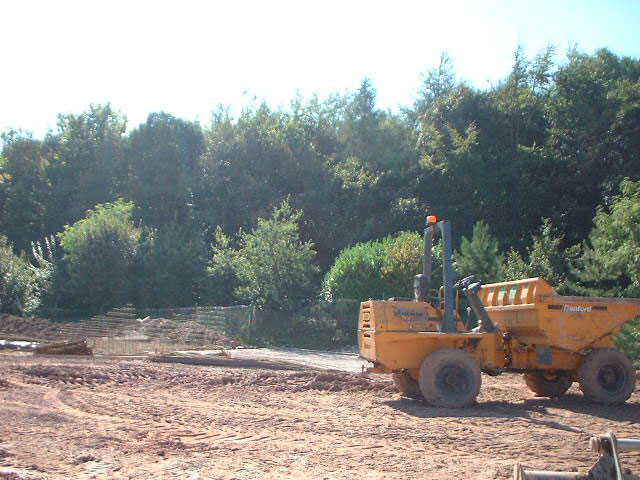

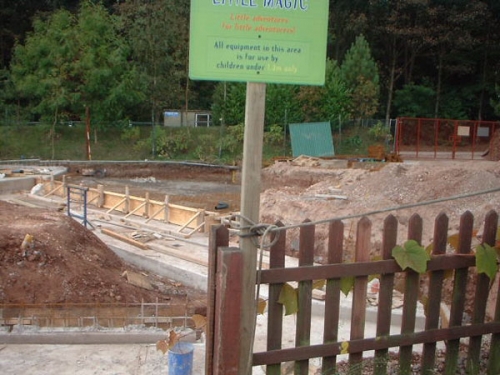

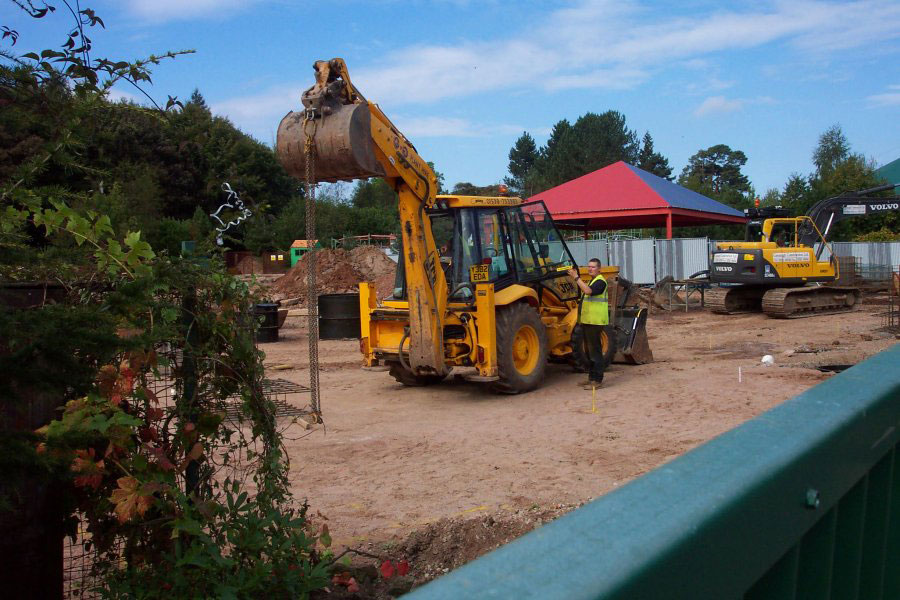

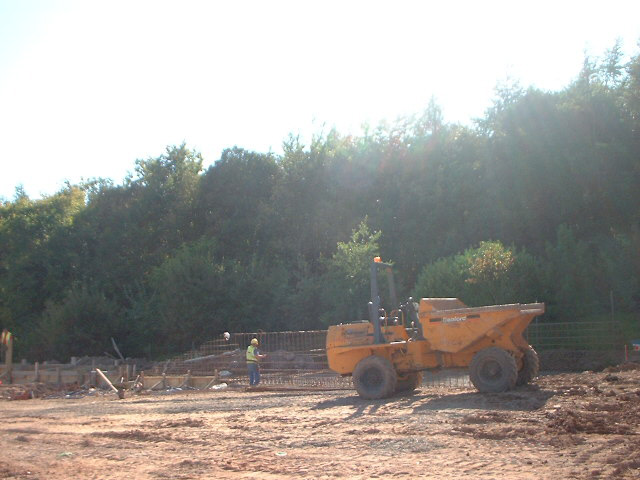

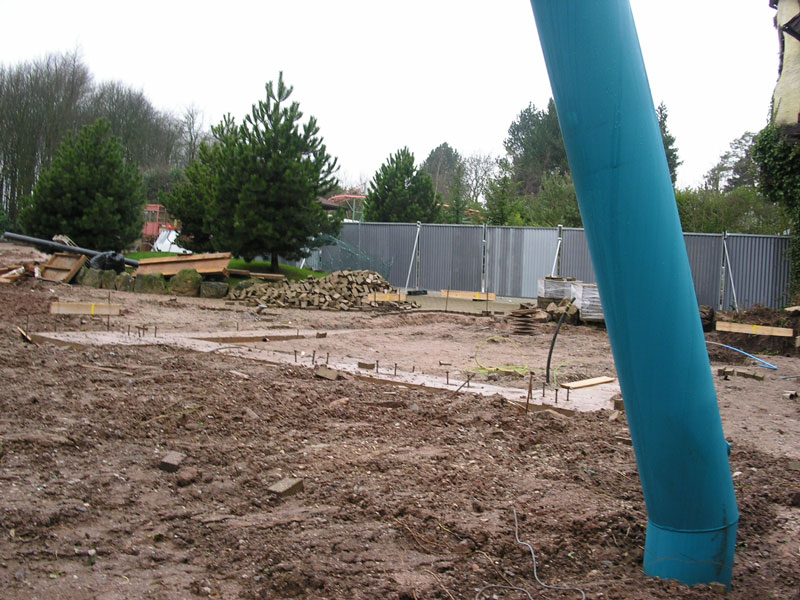

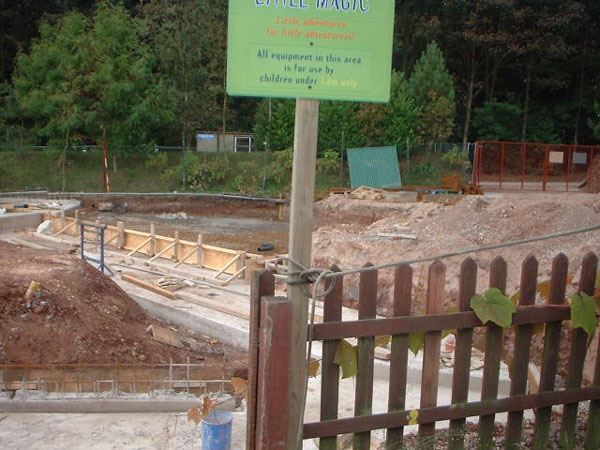

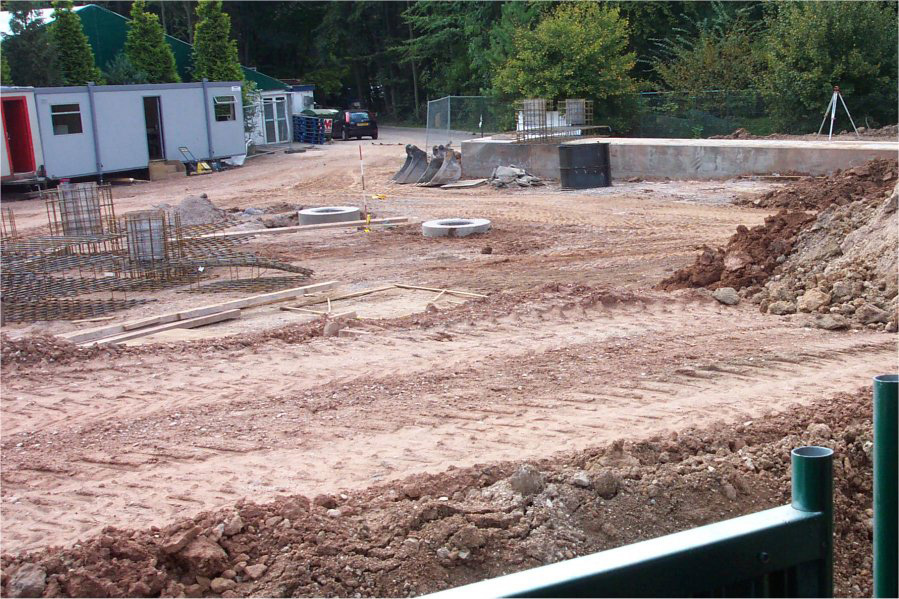

Groundwork starts – preparation for footers begins!

h

Metal for footer foundations can just be made out.

h

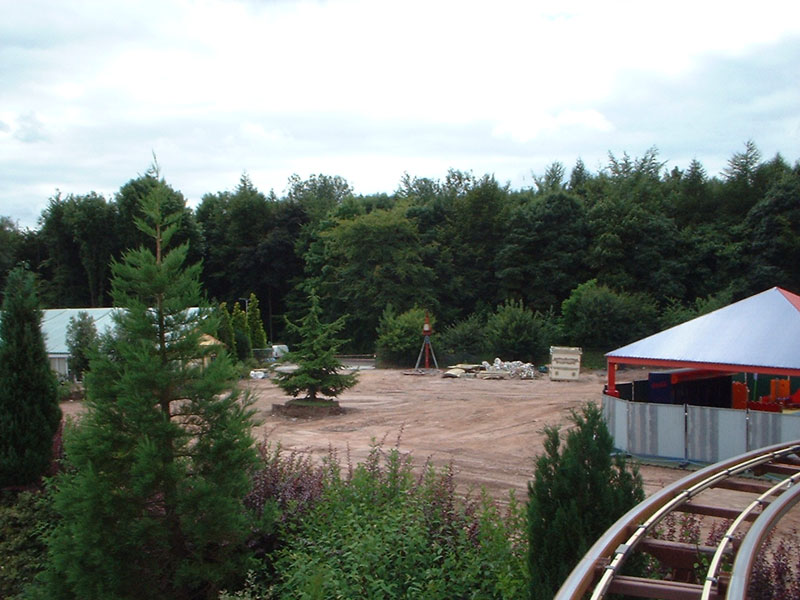

View from Squirrel Nutty – overview of work-site.

h

More clearance has taken place, as seen from Squirrel Nutty.

h

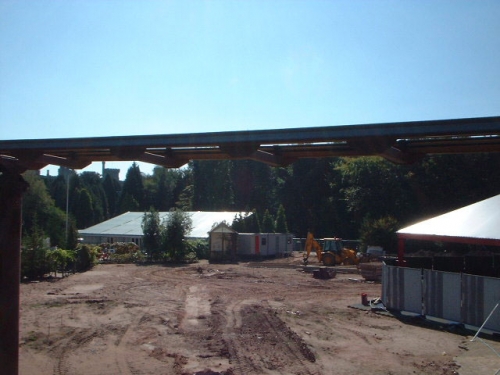

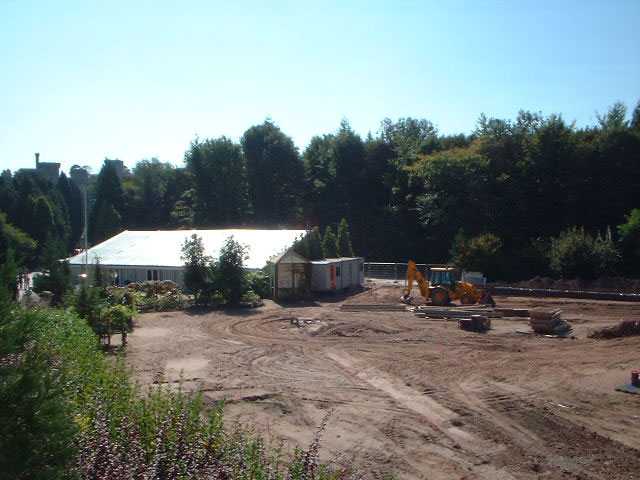

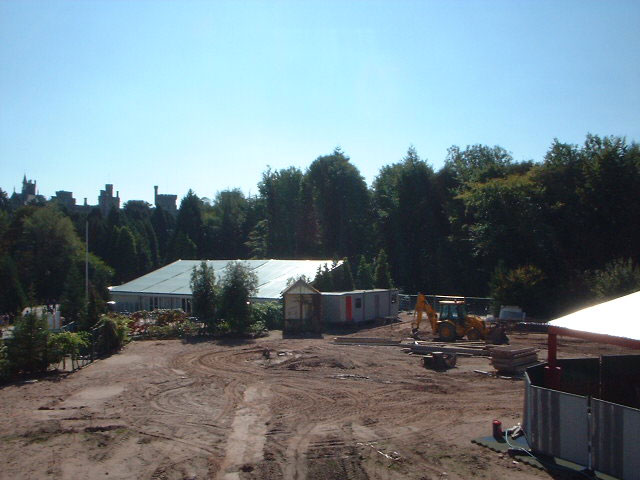

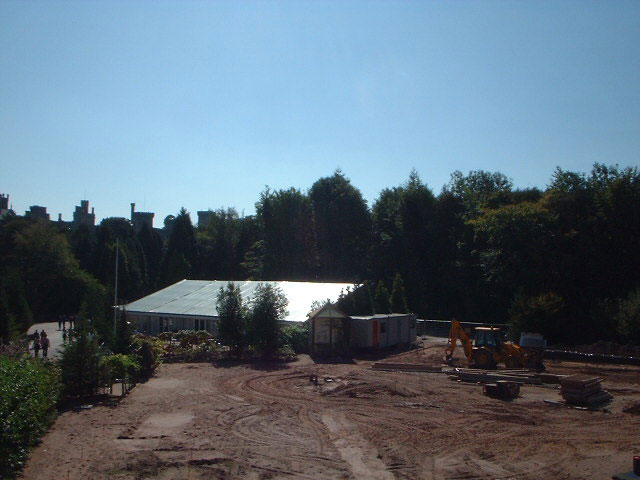

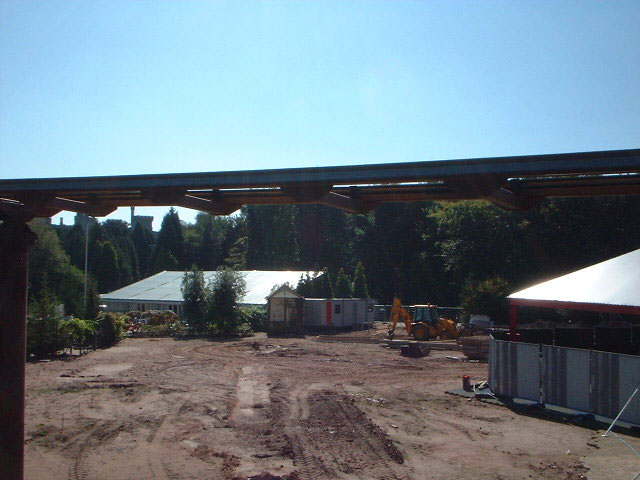

Porter cabins have been erected near the hospitality marquee.

h

The rest of the trees have been cleared in preparation for groundwork!

h

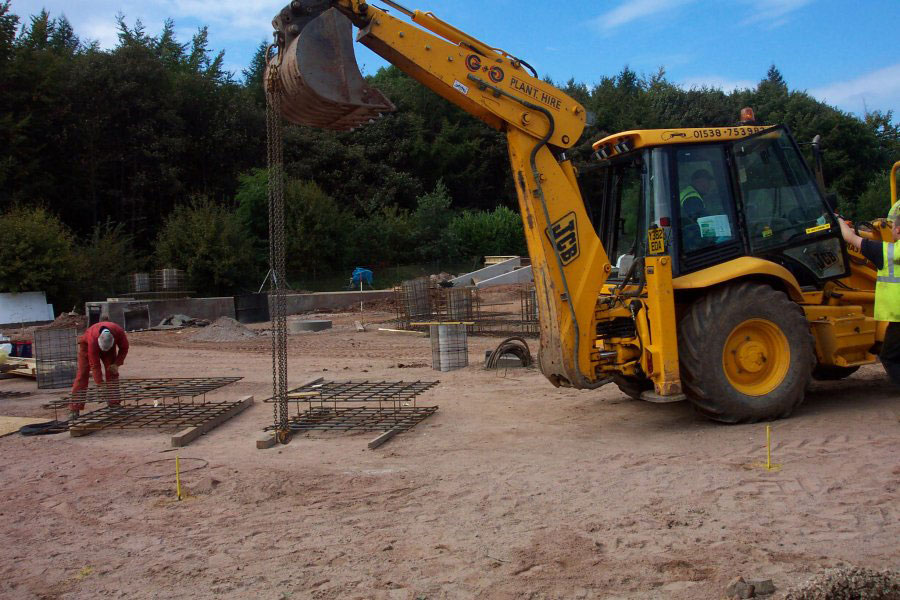

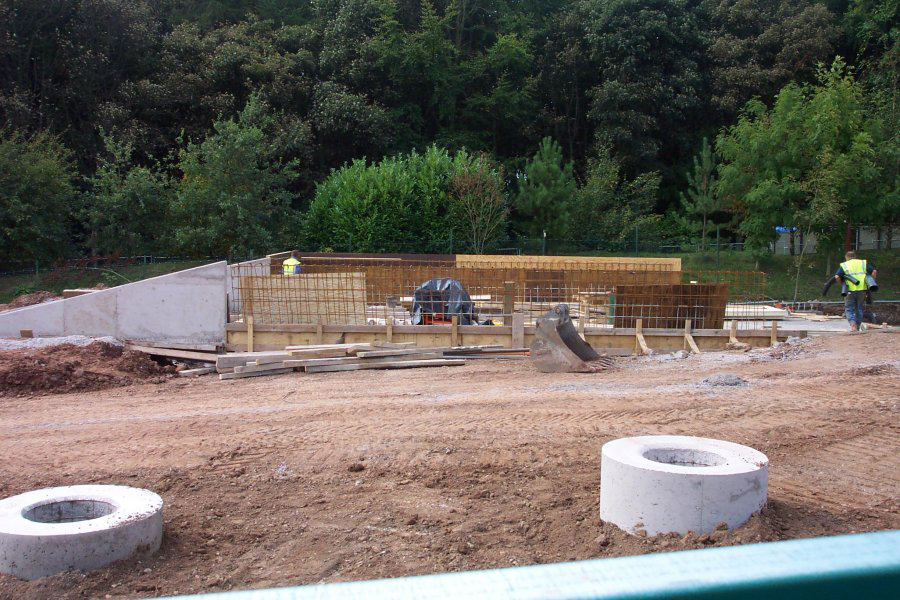

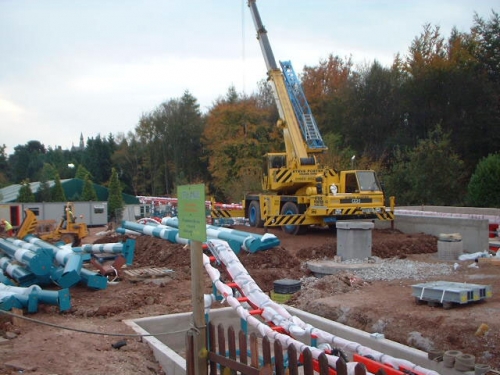

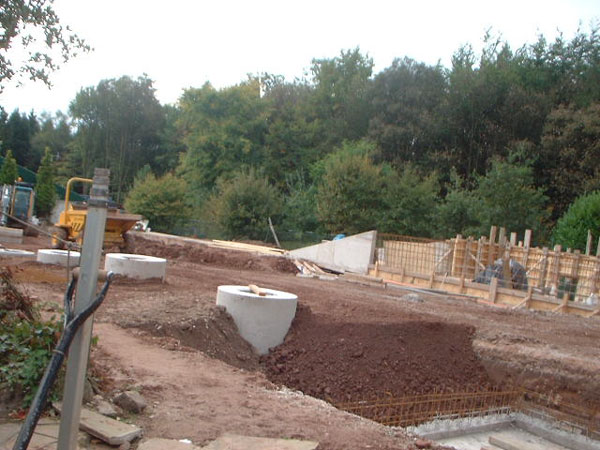

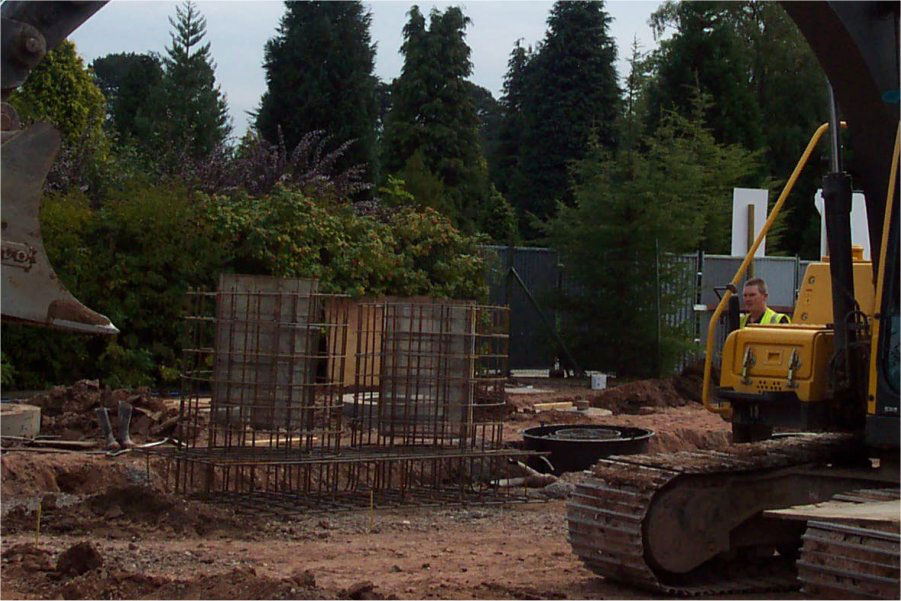

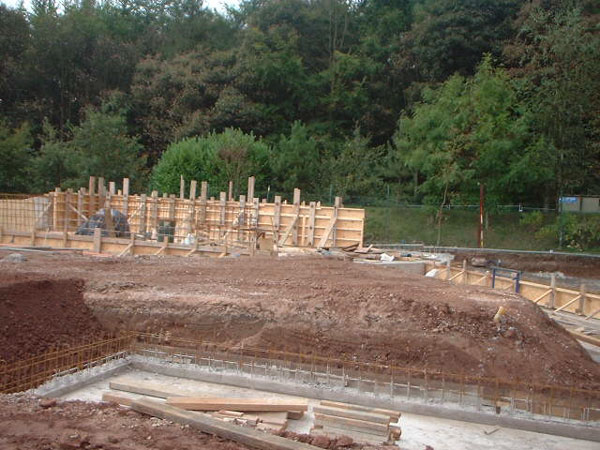

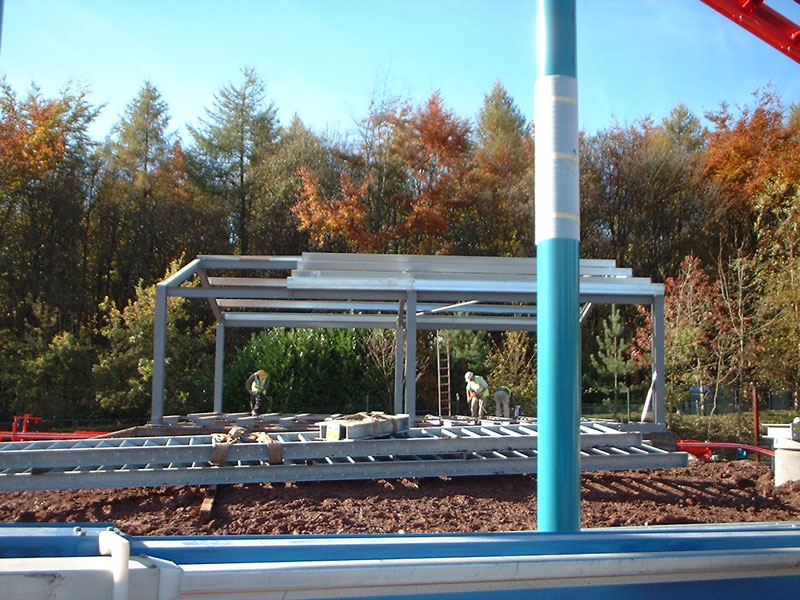

Wooden and metal framework has been constructed to form concrete bases for the station.

h

Here you can see the framework from an alternative angle.

h

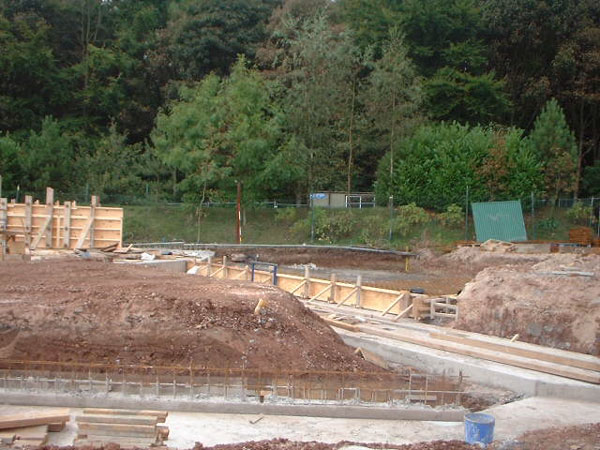

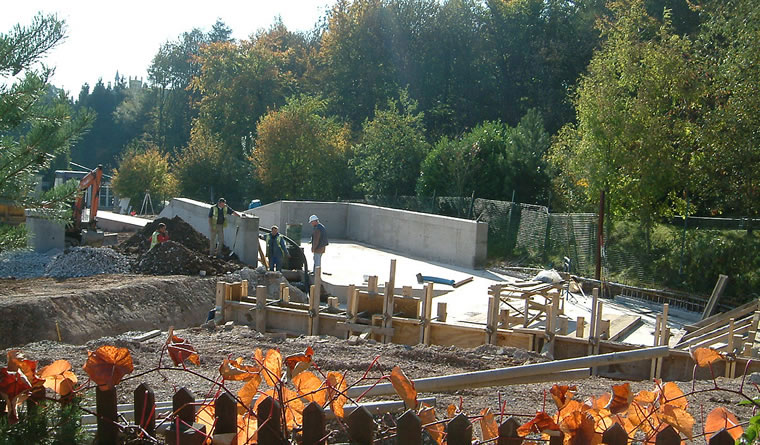

Concrete has already been poured in some places.

h

Metal framework erected.

h

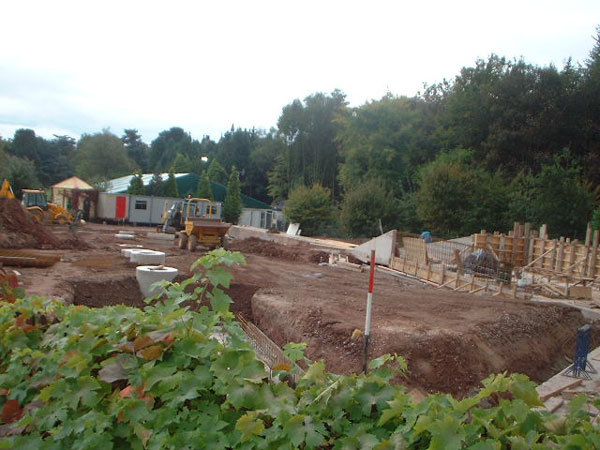

Work on the station area commences.

h

The advertisement sign up close.

h

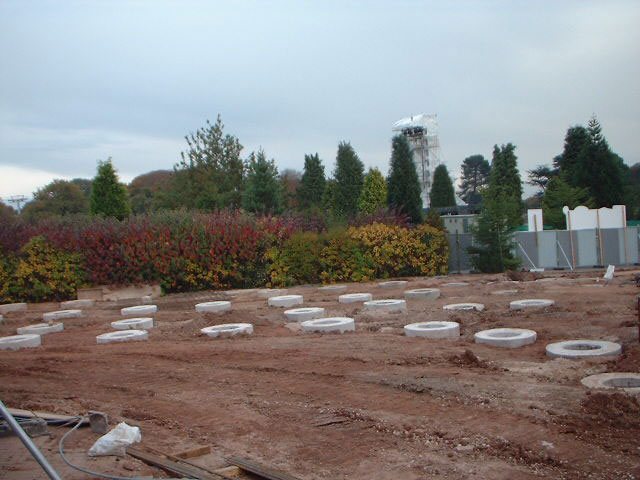

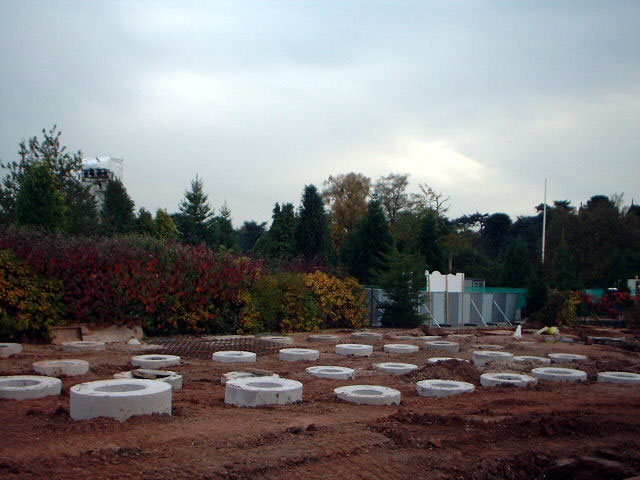

Some footers are now in place, whilst more concrete is being set for the station.

h

More concrete grids are laid.

h

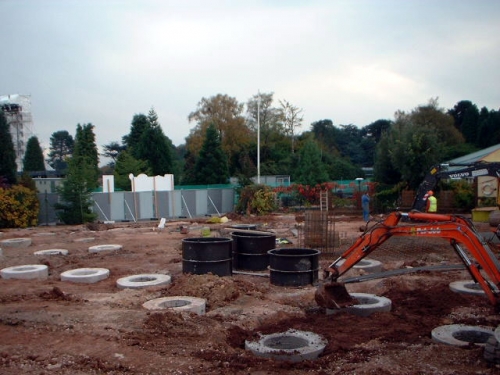

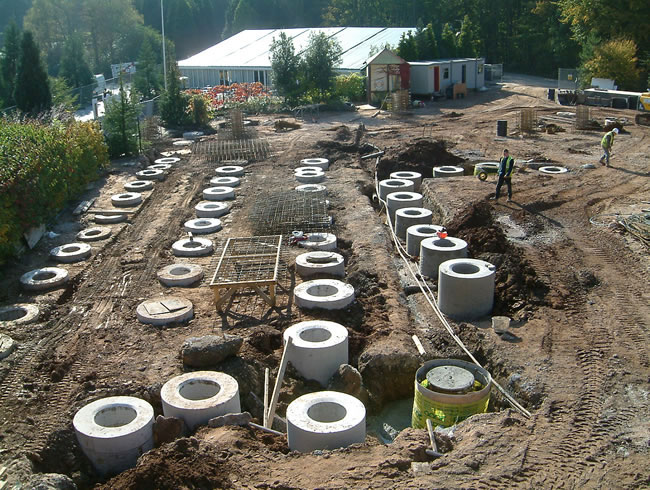

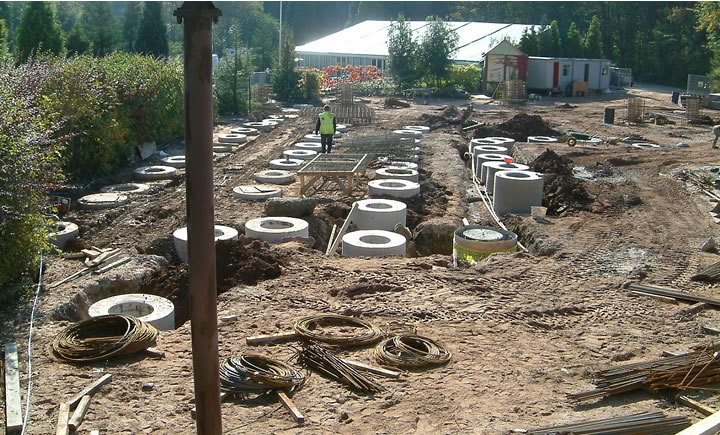

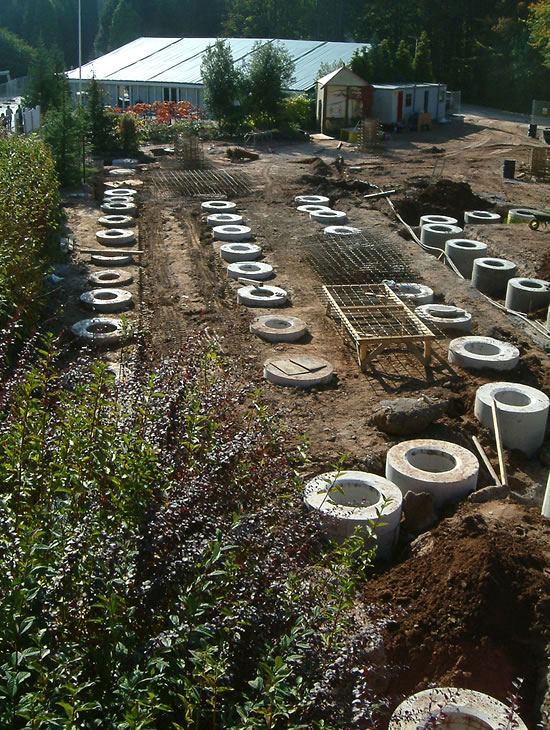

More foundations for the station.

h

Preparation for more groundwork continues.

h

Groundwork at both ends of the site is taking place.

h

As you can see most of the work is taking place near to the fence at present.

h

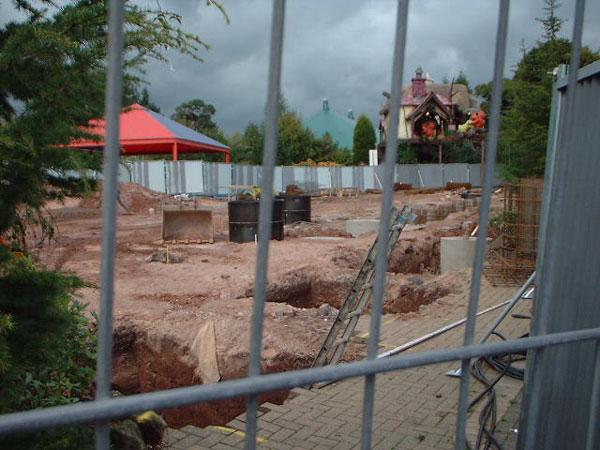

Large foundation holes have started to appear.

h

Many more footers have popped up.

h

The station area is starting to take shape, lots more concrete poured.

h

Here you can see how much concrete has actually been poured for the station area.

h

The station structure begins to take shape.

h

Here you can see an overview of the construction so far.

h

As you can see, most the footers are now in place.

h

You can start to get an idea of what the layout is really going to look like.

h

The footers are much closer together than expected.

h

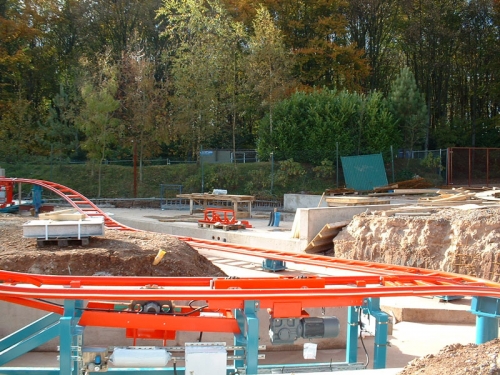

Groundwork near the station continues – the base is looking fully concreted now.

h

Groundwork has been leveled off.

h

These footers are ready for support work to commence.

h

More footers installed.

h

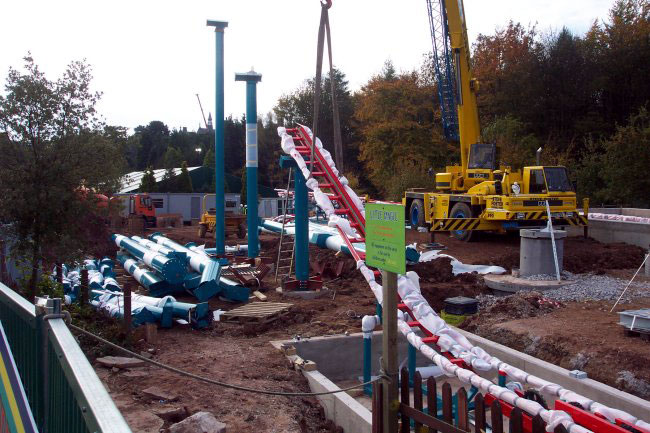

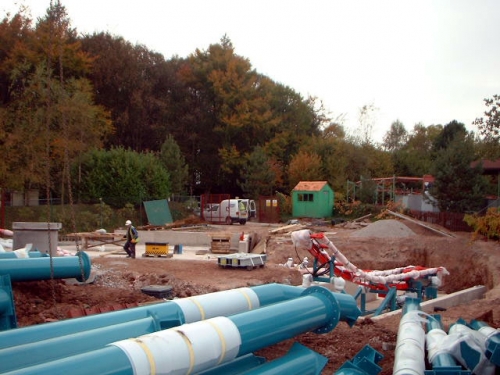

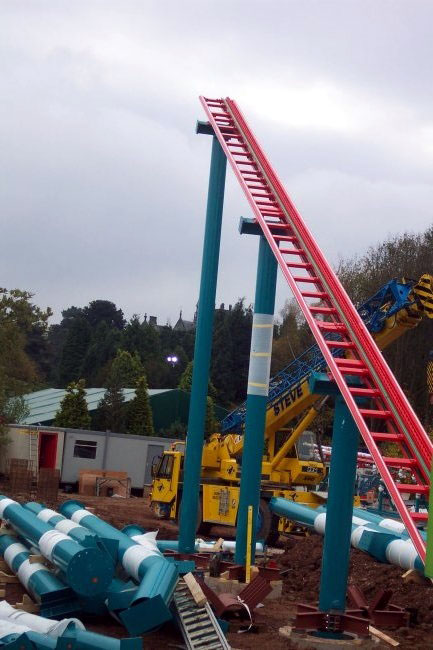

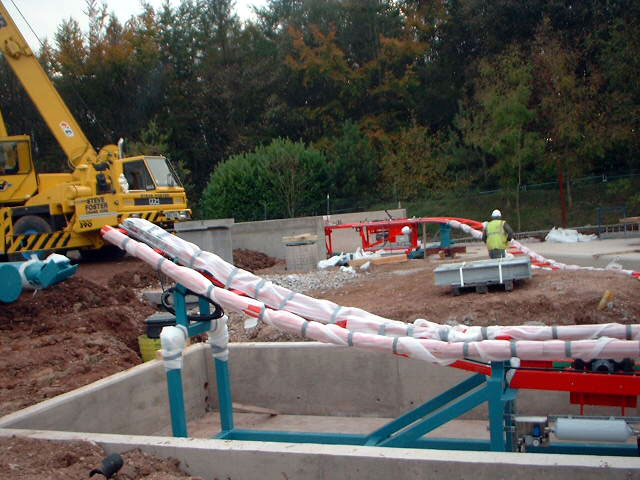

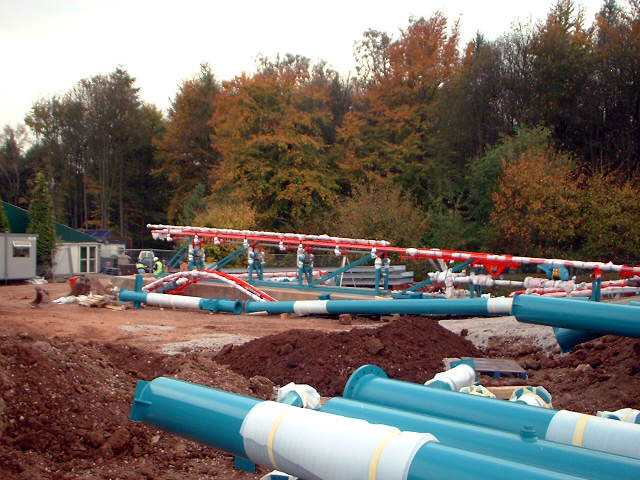

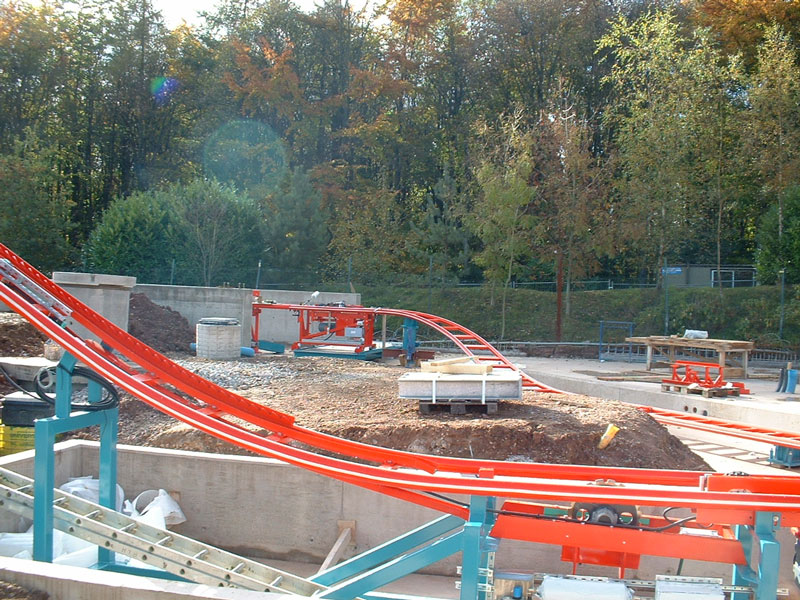

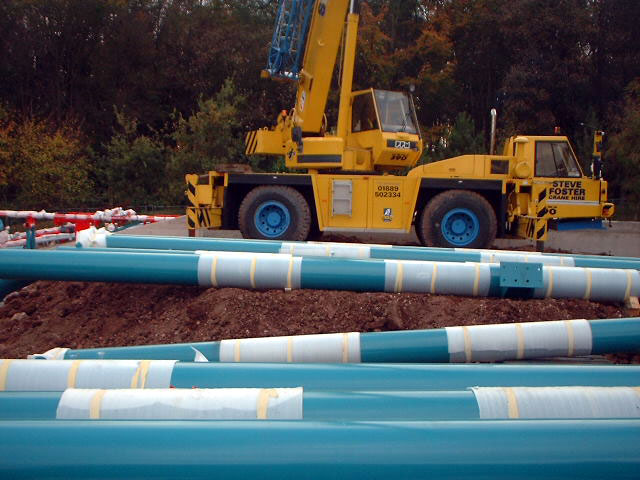

The turquoise-green supports and the red track have finally arrived! You can see that the supports are protected from any damage with small pieces of foam wrap.

h

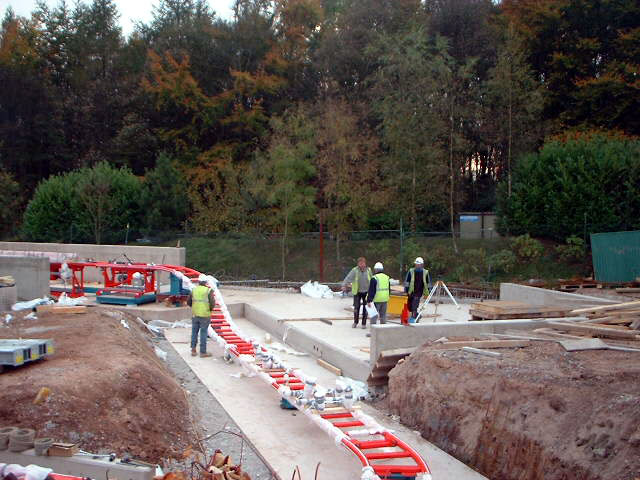

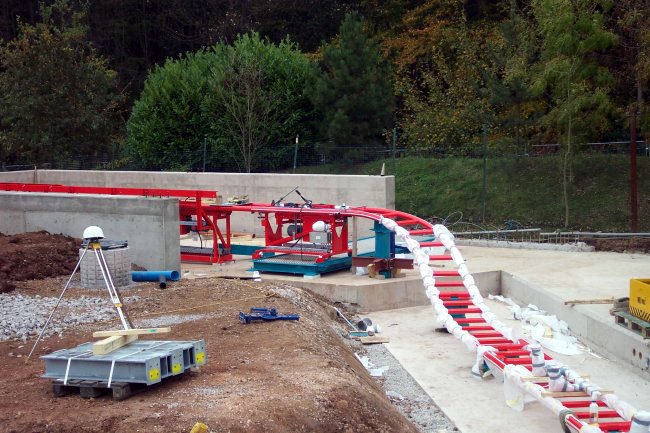

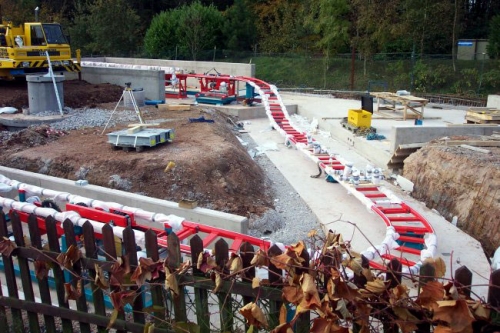

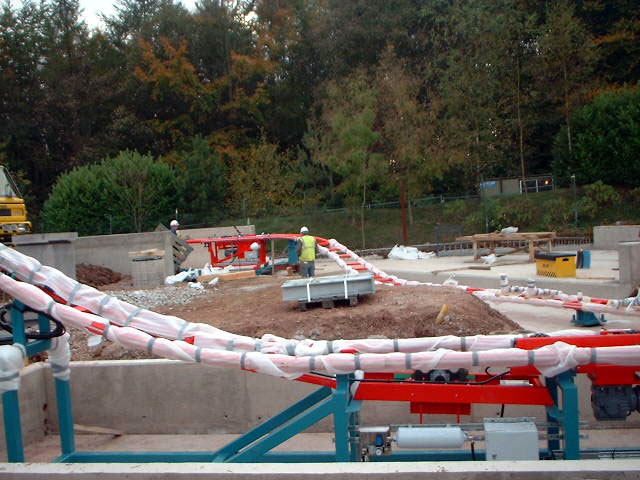

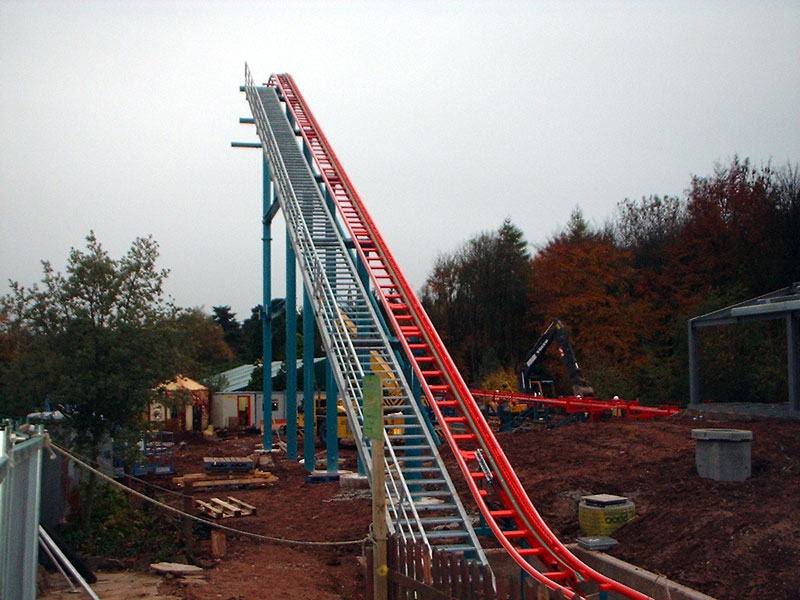

Track erection has already begun; here you can see the brake run track.

h

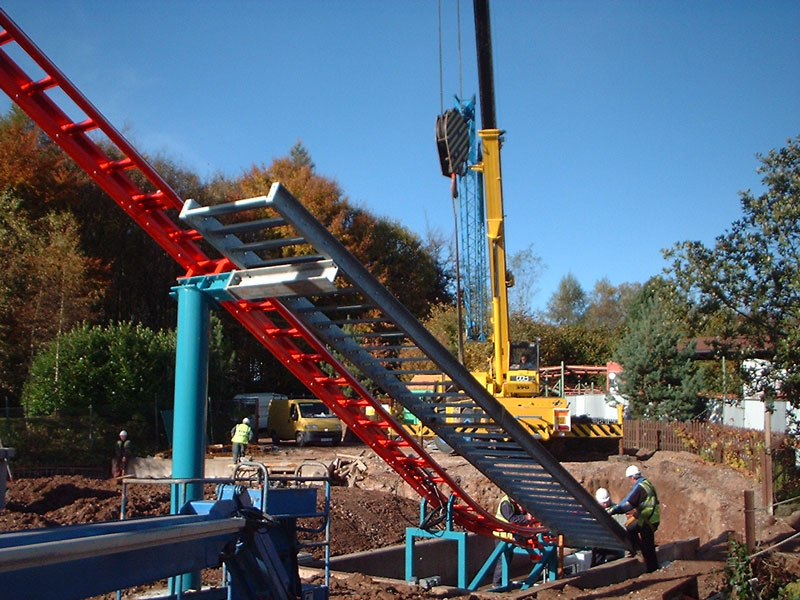

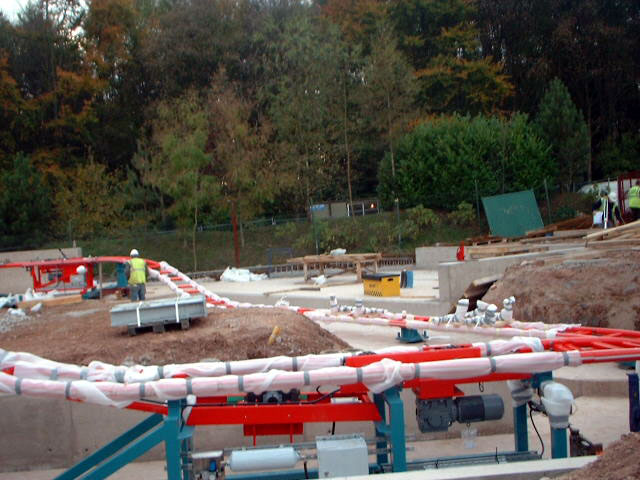

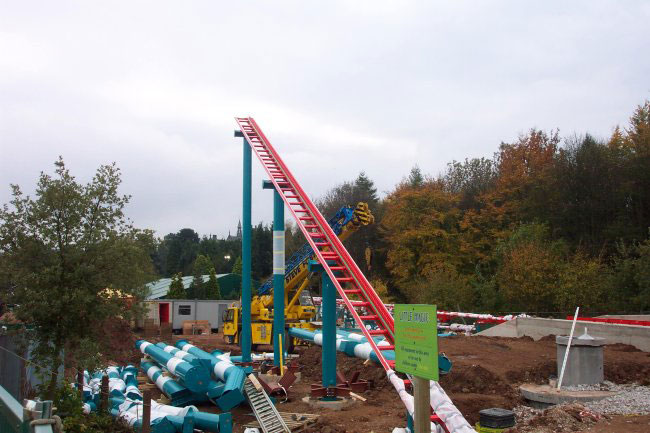

Construction on the lift hill has begun. Coaster track is being erected at the same time as the supports!

h
h
h

The lift hill construction from other angles – you can also see the station track now in place!

h

Here you can see the electronics for the chain lift.

h

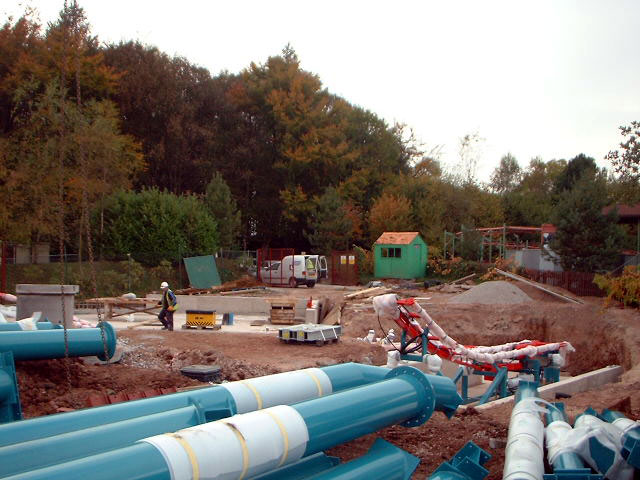

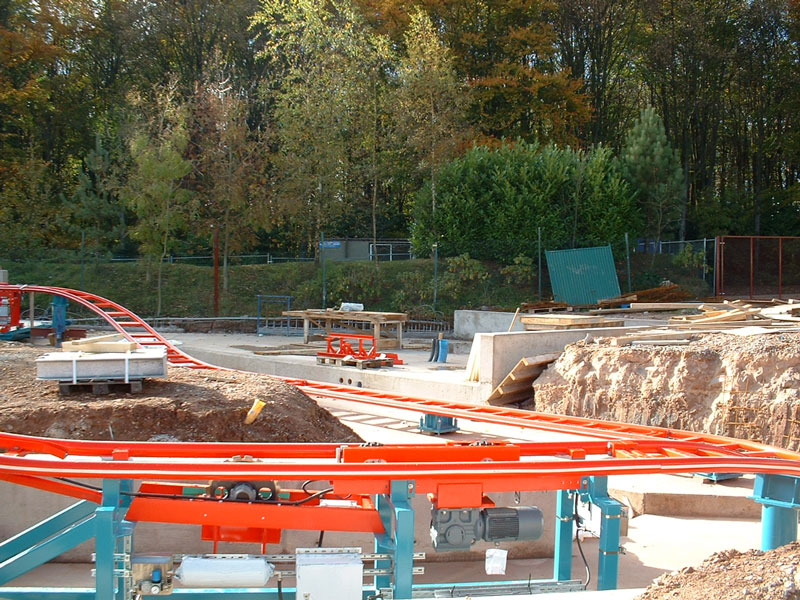

The station track is in place, with the its groundwork coming along nicely.

h
h
h

Here you can see progression throughout the day on the erection of the lift hill. Construction is coming along very quickly; if this rate continues we estimate the full circuit will be completed in less than two weeks!

h

Work continues on the station.

h

Not really much to report in this area.

h

From Adventure Land you can get an idea of just how big this ‘family coaster’ is going to be!

h

Not much happening in the station, although the protective wrapping has been removed.

h

There were no workmen on site today.

h

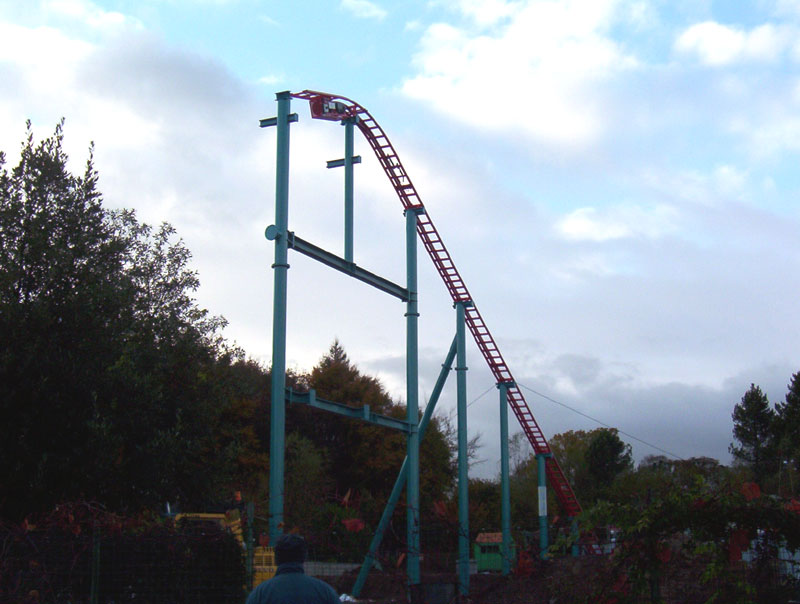

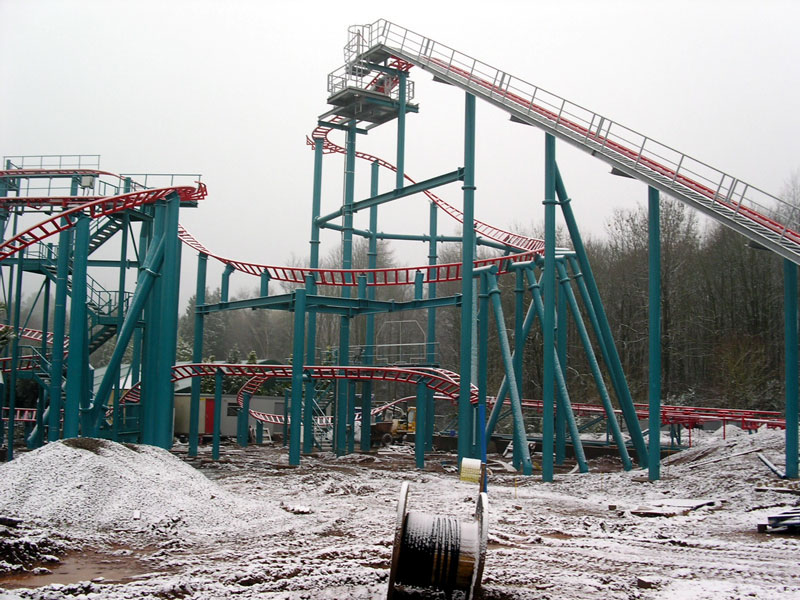

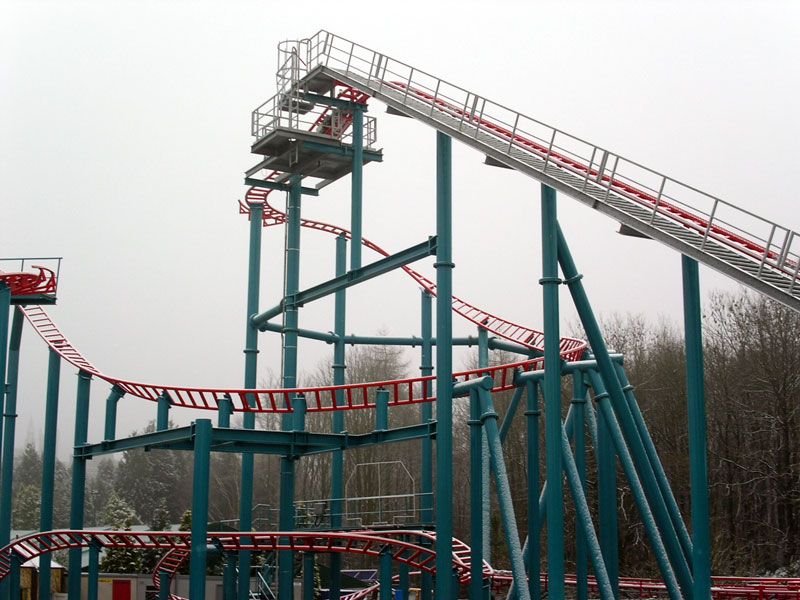

The lift hill is now complete; you can now get an even better idea of how high this coaster will stand!

h

A view of the lift hill from the adventure playground!

h

In this picture you can see the support wire which is used to keep the structure vertical until construction finishes.

h

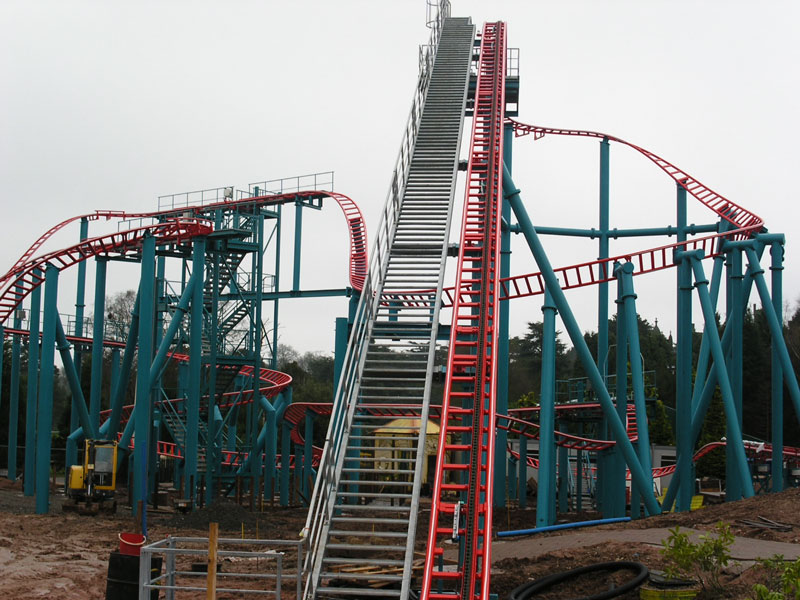

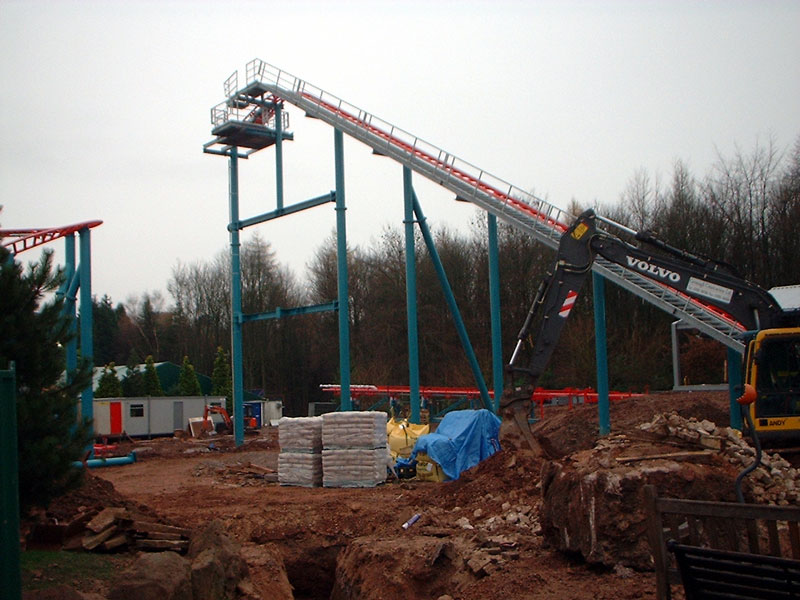

Here you can see the stairway for the lift hill being put into place.

Lift Construction

By the end of the day the lift hill stairway was complete.

h

The station structure begins to take shape.

Helix Construction

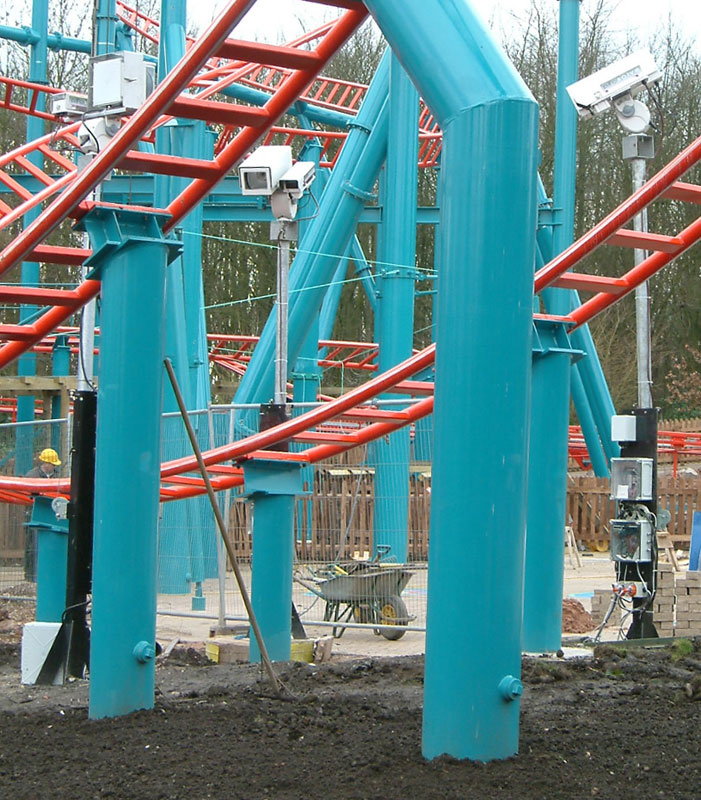

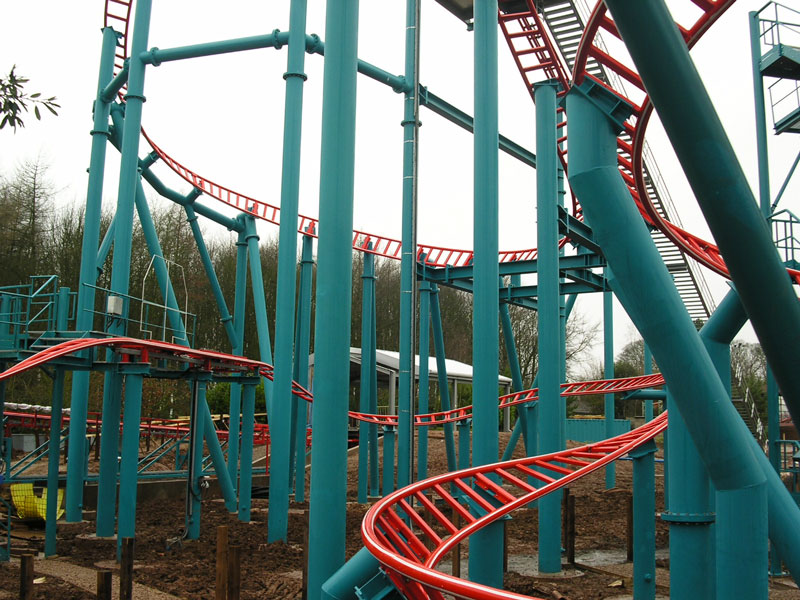

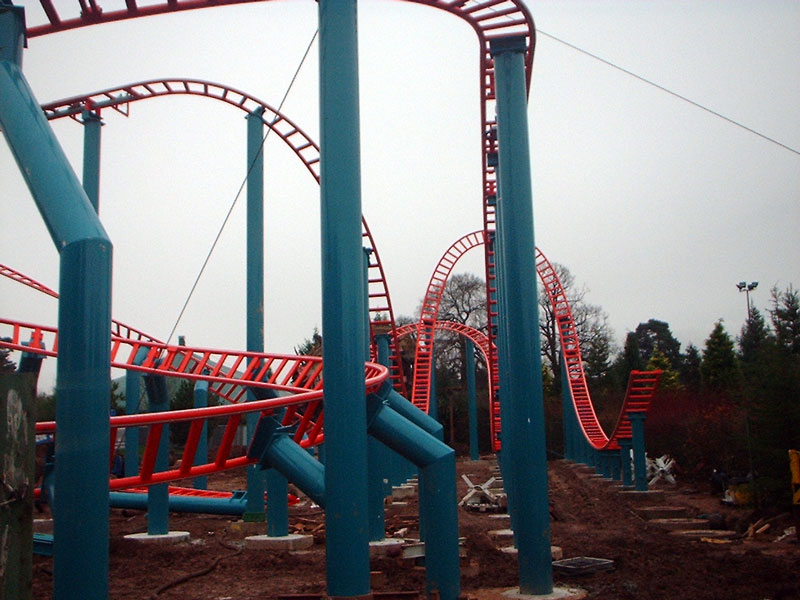

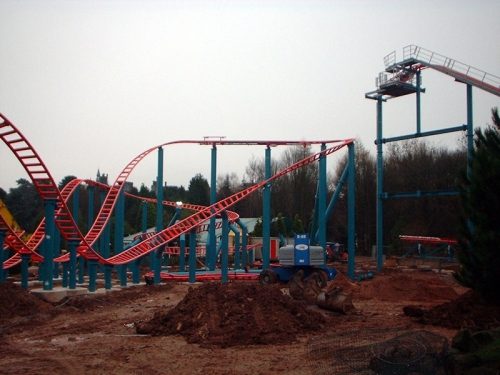

Track construction has come on dramatically. Here we can see the tight helix section.

h

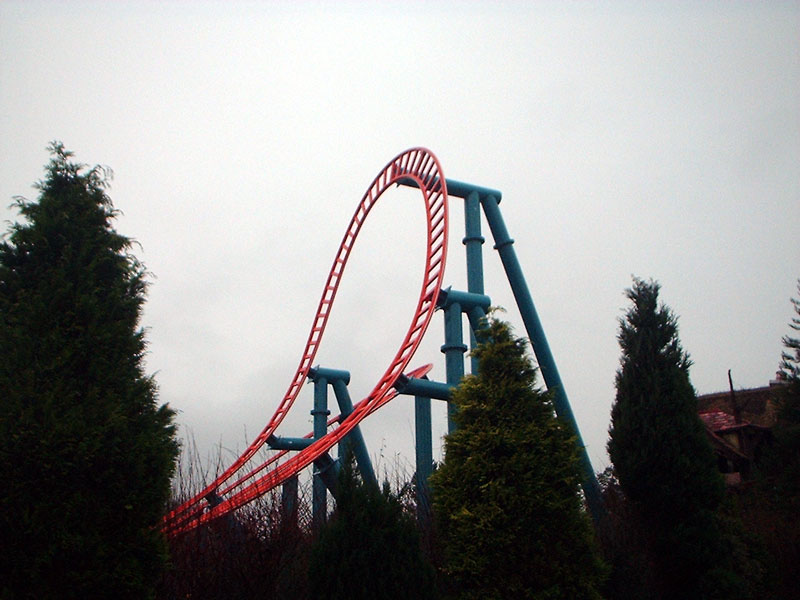

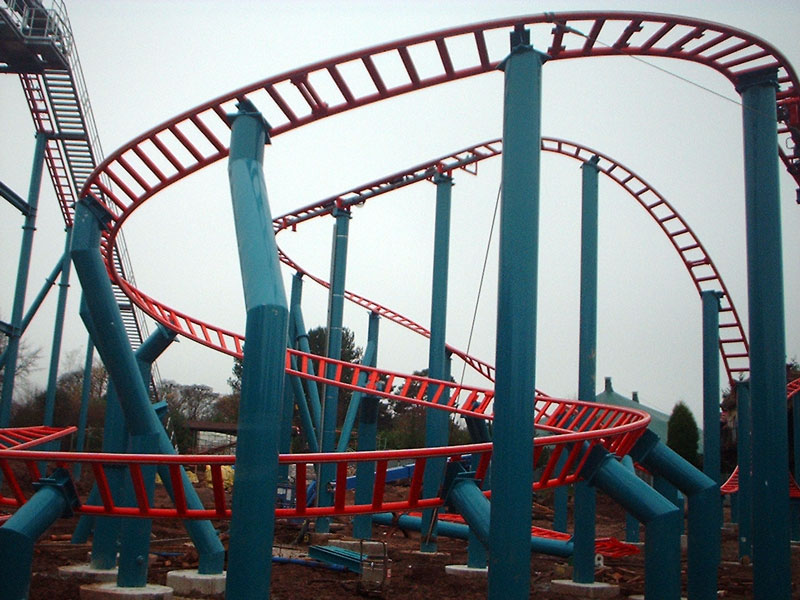

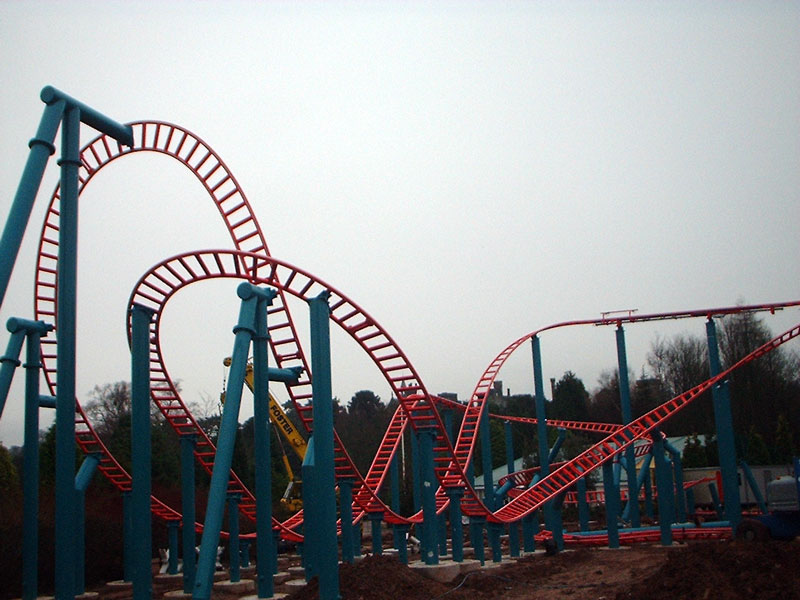

The over-banked turn now in place! Nearly as over-banked as the final turn on Millennium Force!

h

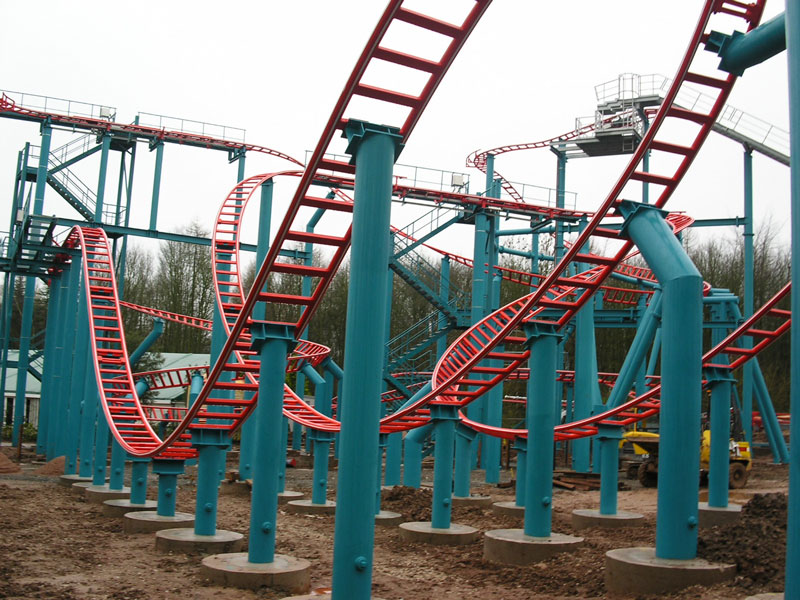

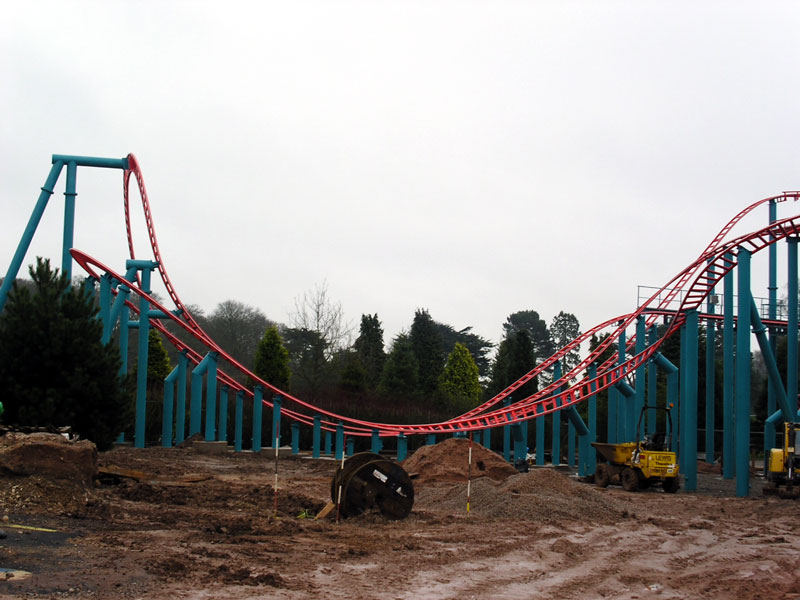

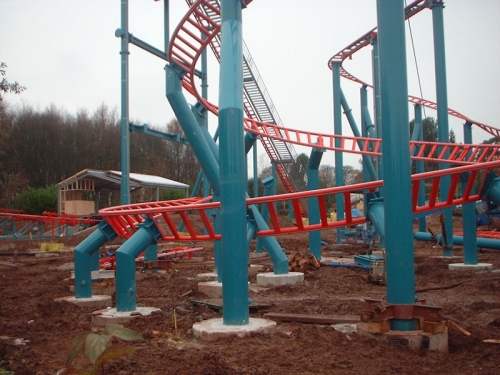

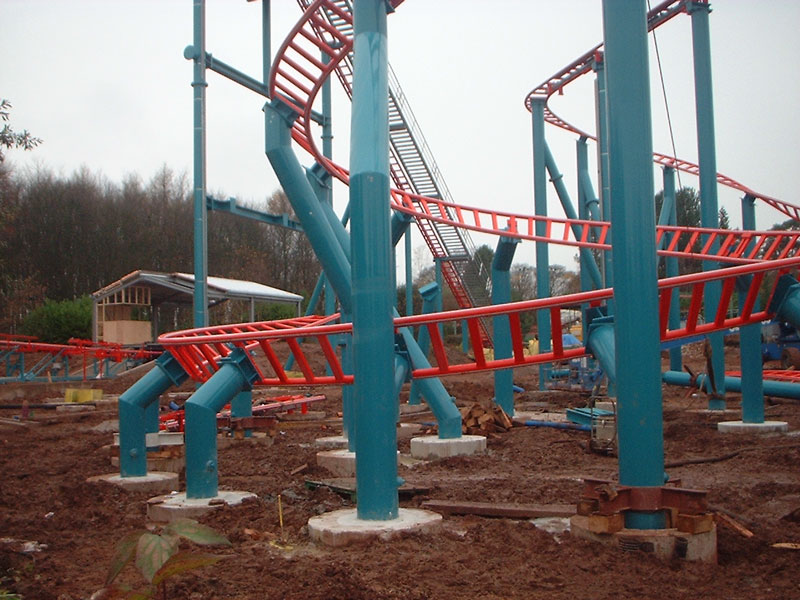

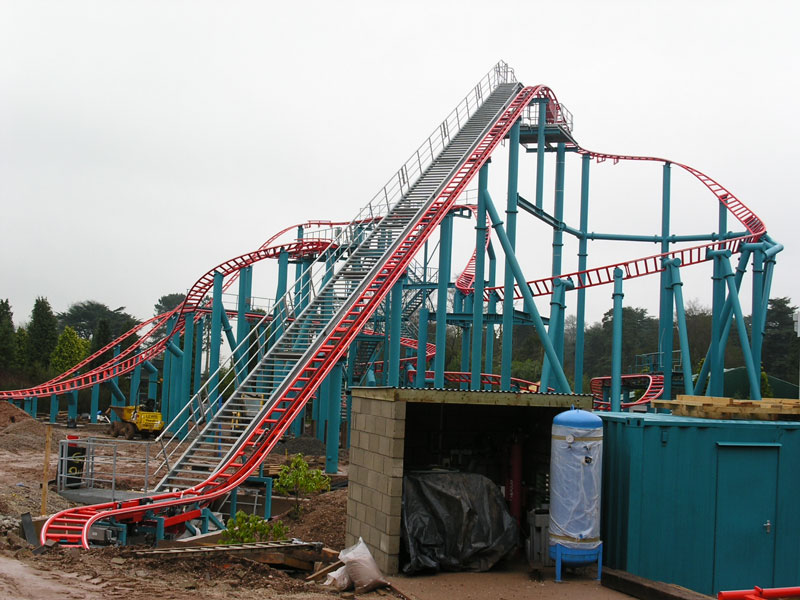

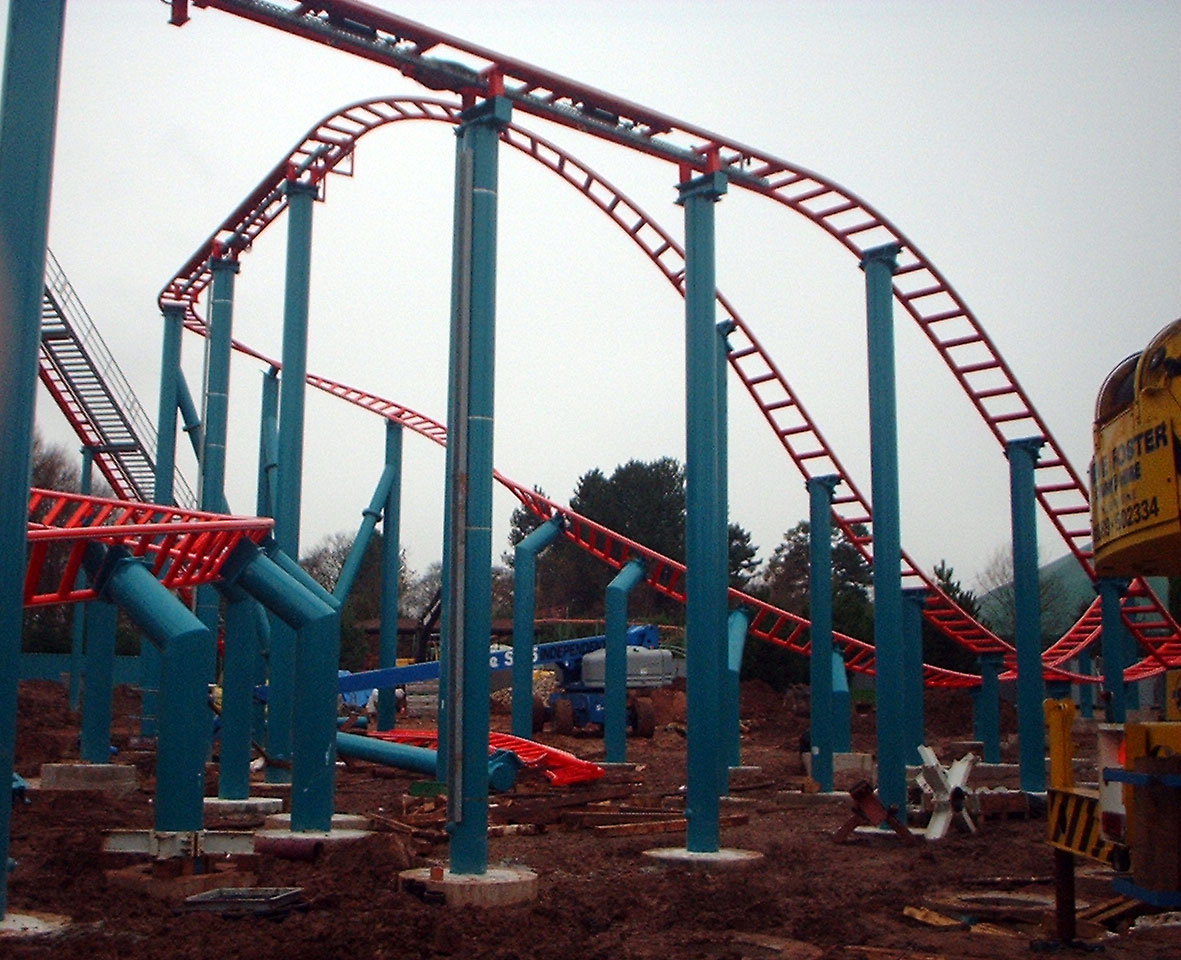

As you can see, most of the track is now in place – the final major section not yet in place is the first drop.

h

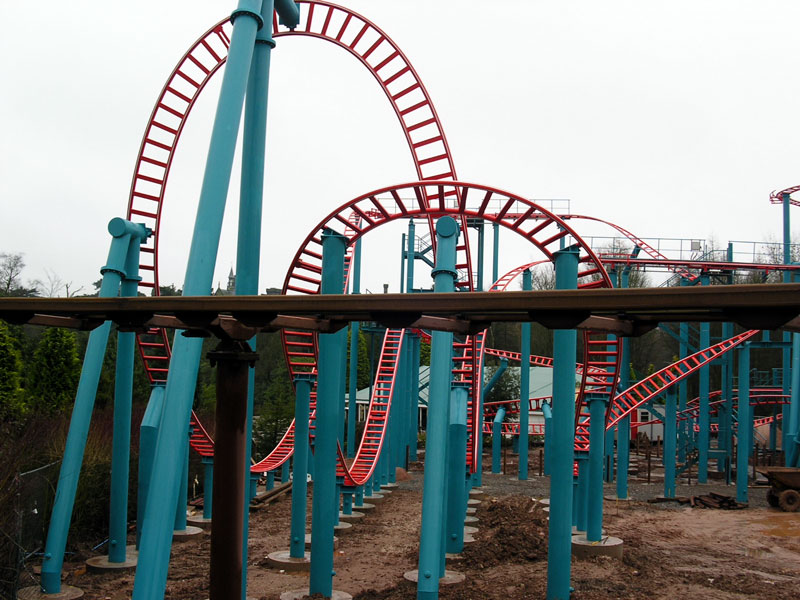

You can see the midcourse section from different angles.

h

You may notice a few block brakes; these are needed as there are so many cars used on a spinning mouse ride.

h

From this angle the track certainly doesn’t look like a ‘family coaster’.

h

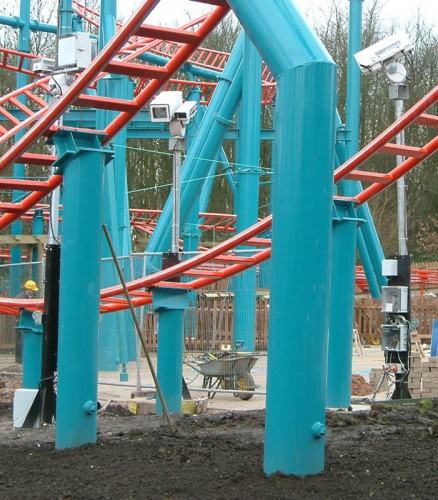

A metal duct has been attached to the side of this support of a block brake section, possibly to protect the wiring.

h

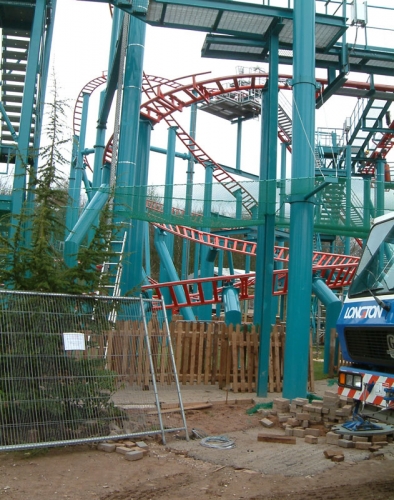

Some uniquely shaped supports are popping up.

h

Preparation for landscaping around the lift hill has started.

h

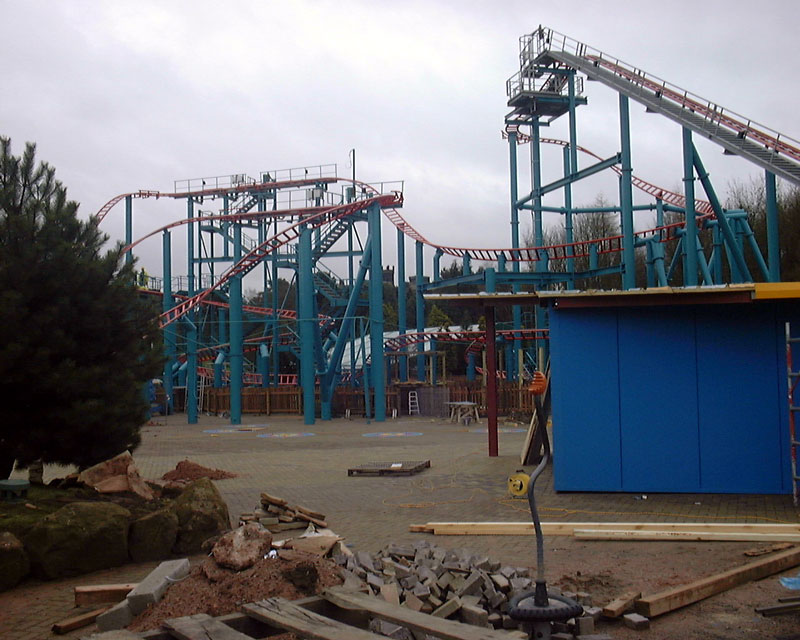

The station is coming along nicely. Landscaping has already started around this area.

h

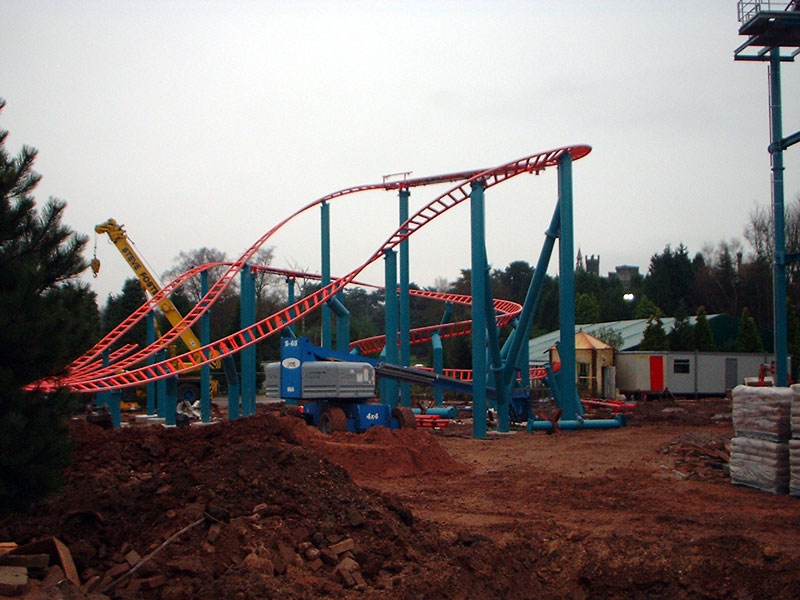

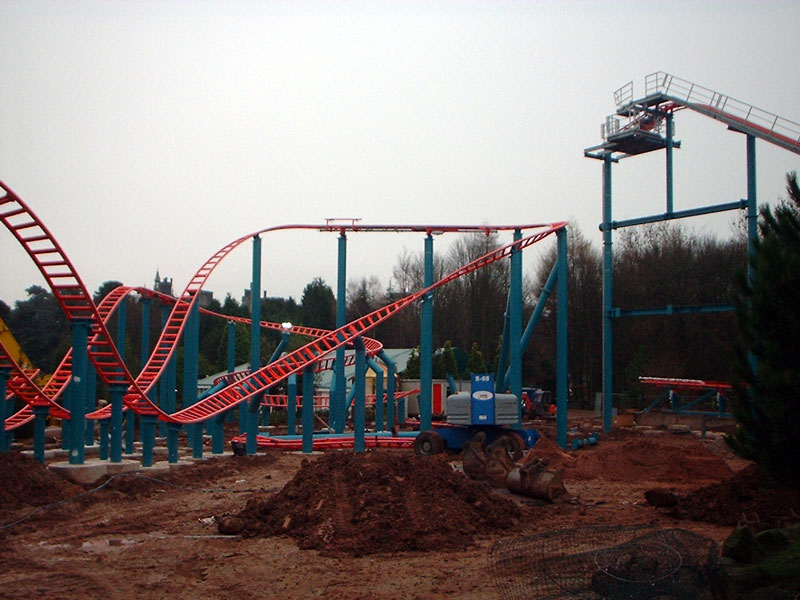

Final pieces of track. We anticipate that they will finish the track fairly quickly, as it’s coming close to the icy cold time of year.

h

You can now see Spinball from quite a distance!

h

The rest of the cars sit waiting in the car park.

h

Each one is wrapped and stored on a pallet.

h

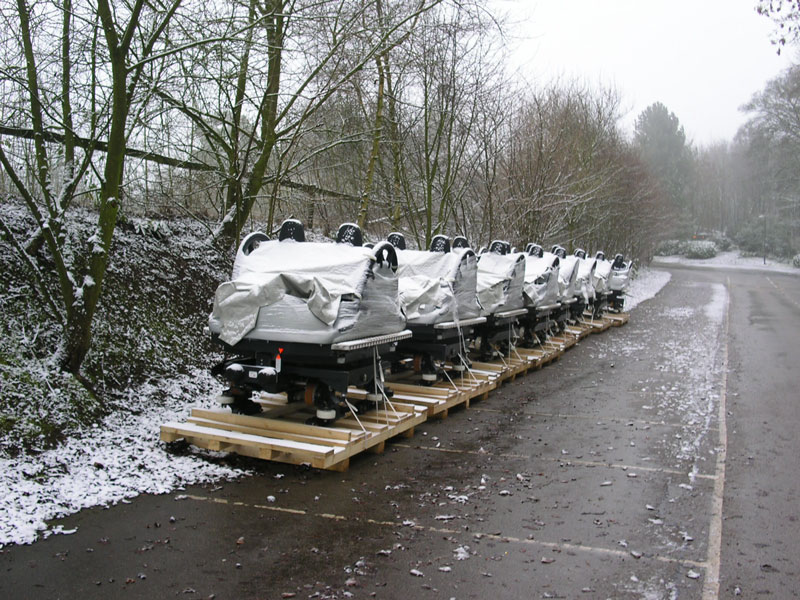

Eight cars are waiting in the car park.

h

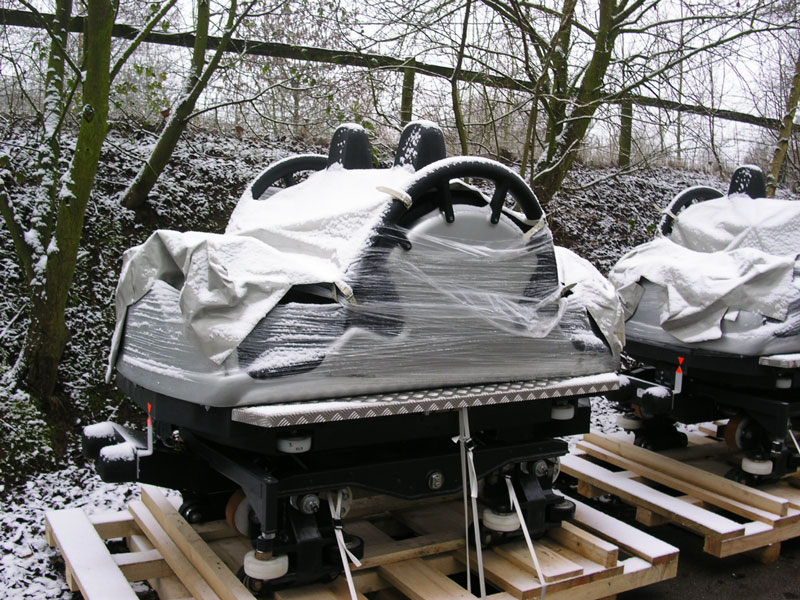

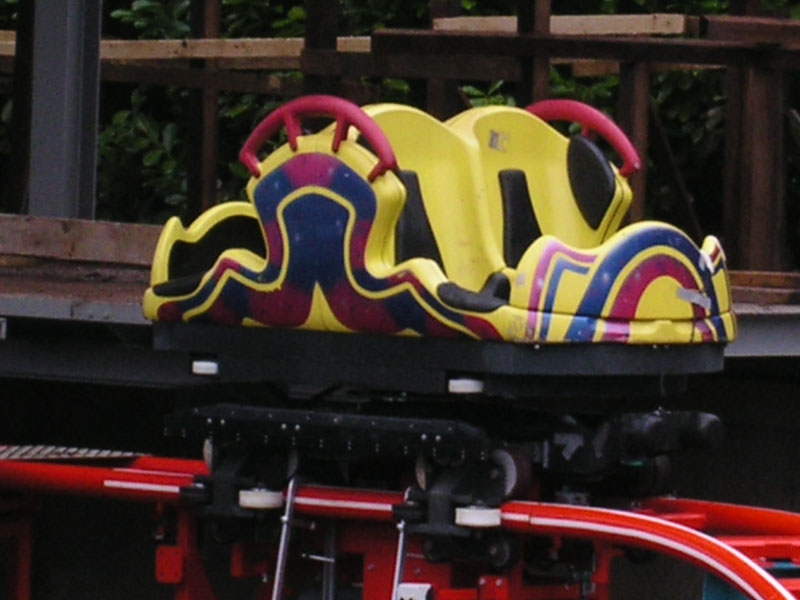

Possibly one of the nine, four-seater Spinball cars, but it’s more likely a test car sent by Maurer.

h

Notice the evacuation steps from the mid-ride brakes dominating the ride.

h

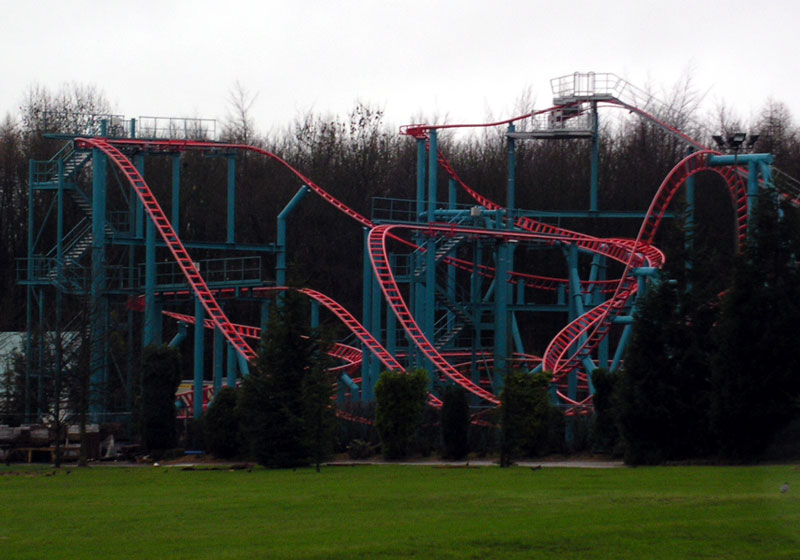

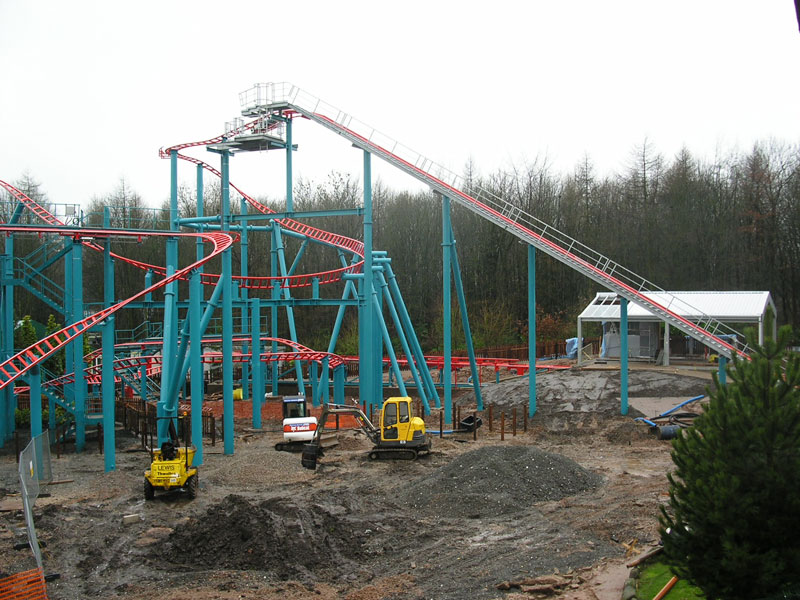

Looking in at the completed Spinball Whizzer, high banks and loads of drops!

h

The first spiralling drop, drops straight into some brakes.

h

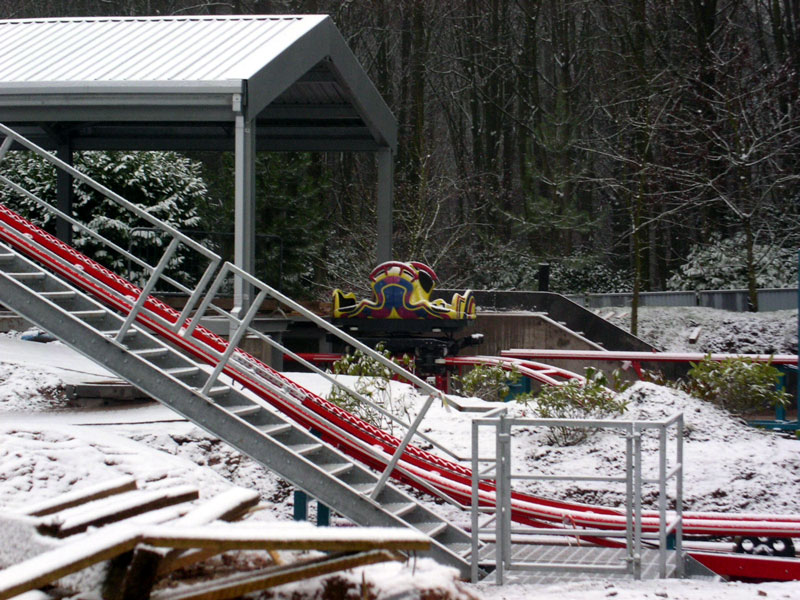

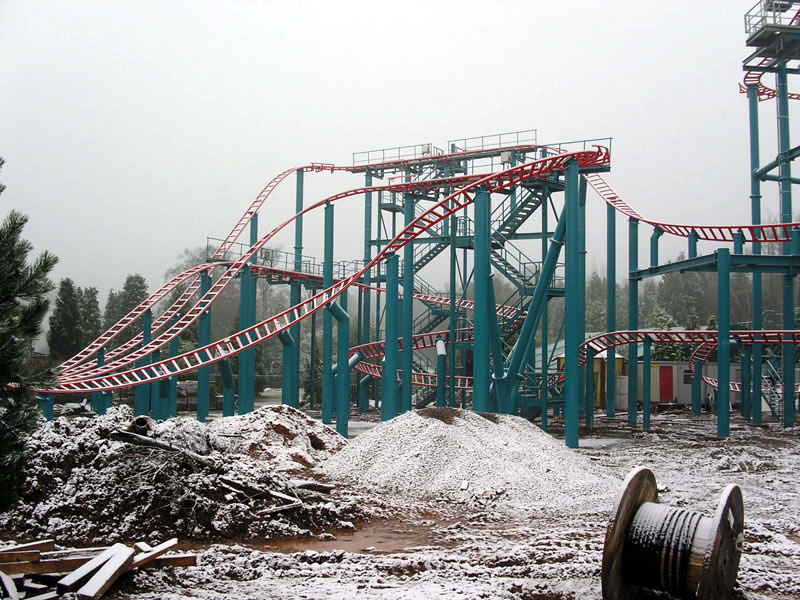

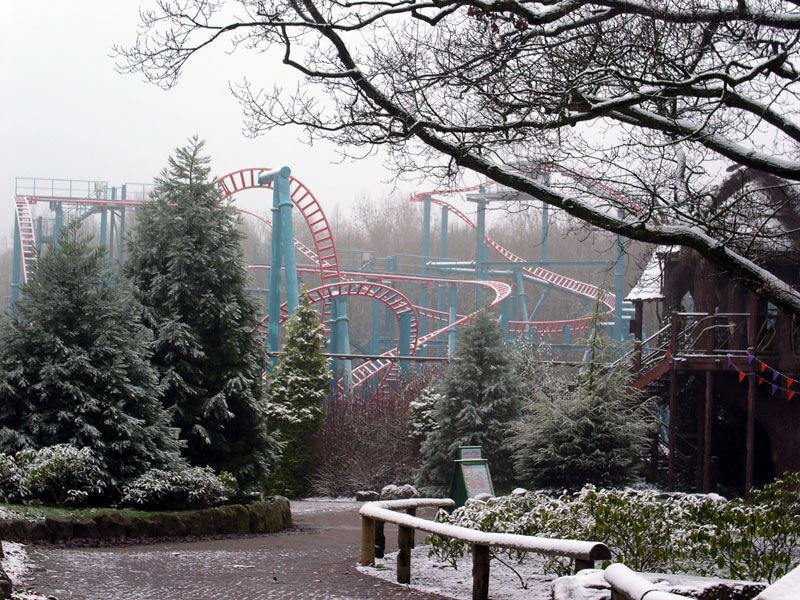

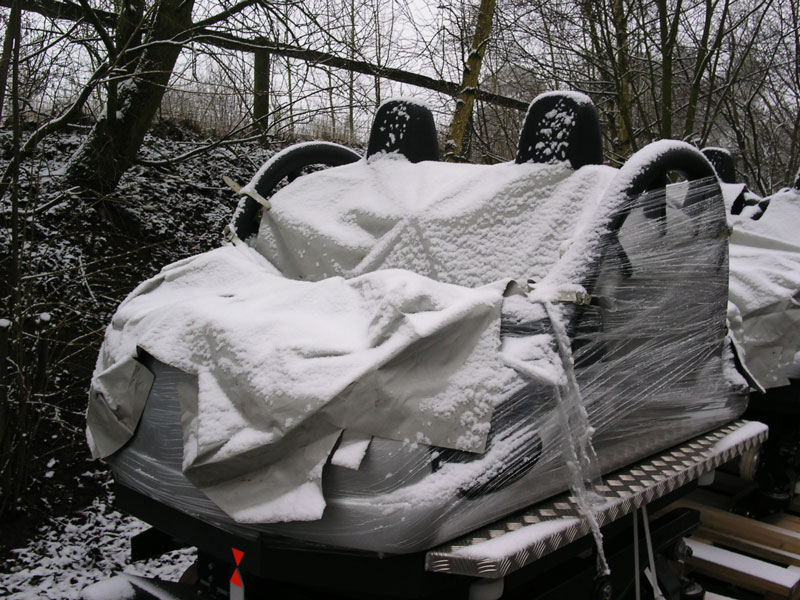

Snow covers the untidy ground.

h

A view of the whole ride.

h

A view even further away.

h

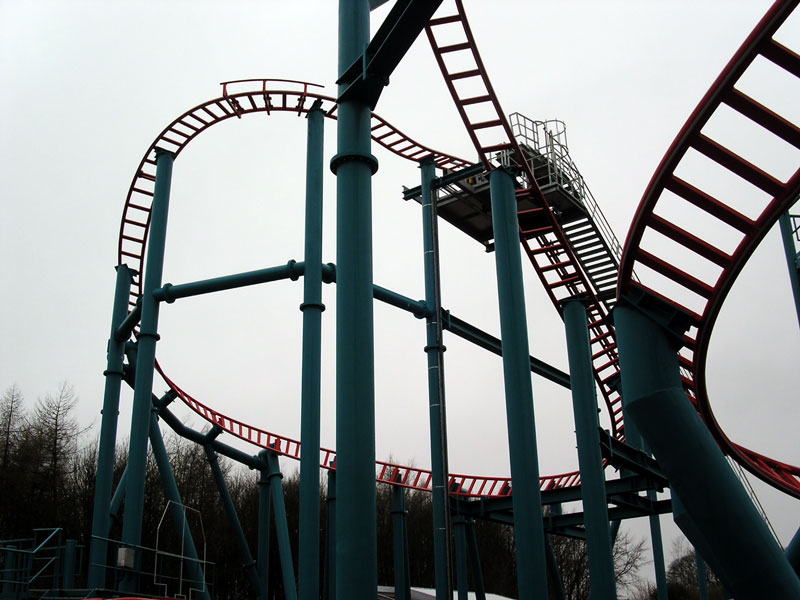

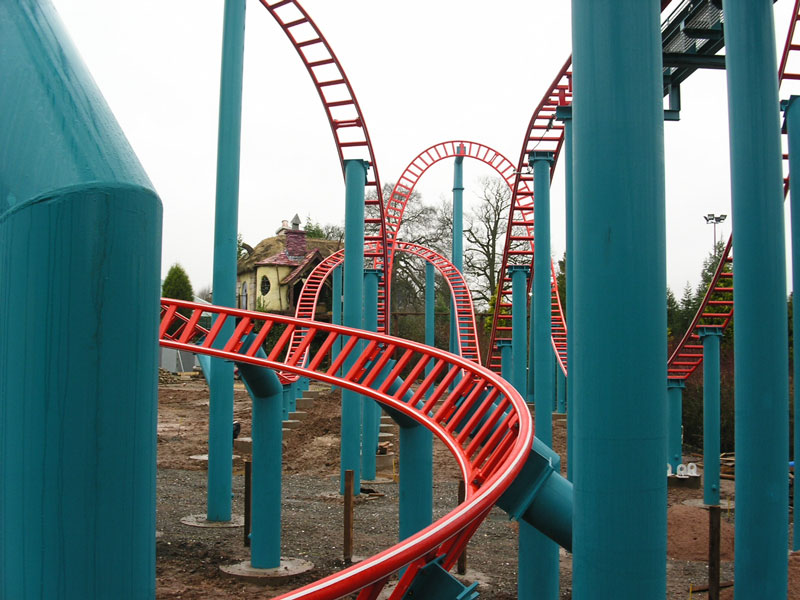

A close up of the helix.

h
h
h

Some close-up pictures showing the finished track layout, without theming.

h
h
h

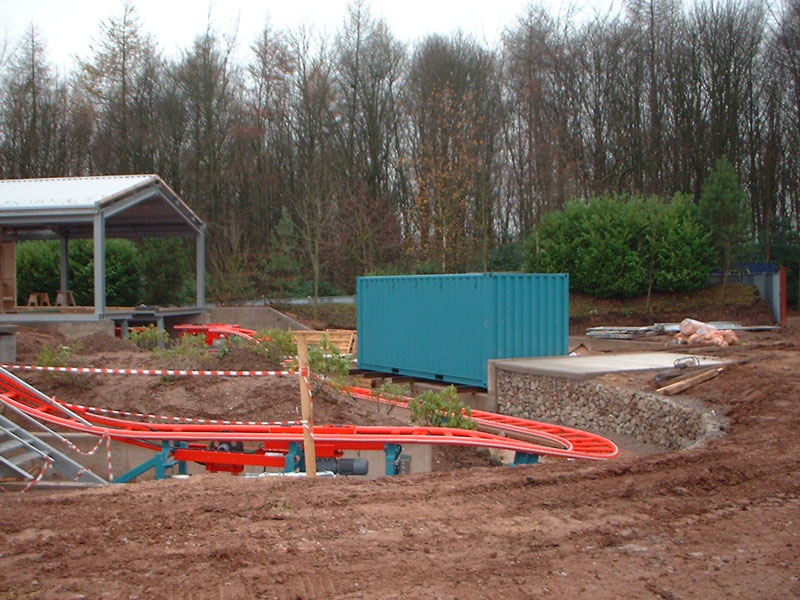

As you can see, the site is still very much one of construction.

h

Spinball Whizzer’s footprint seen from the lift hill.

h

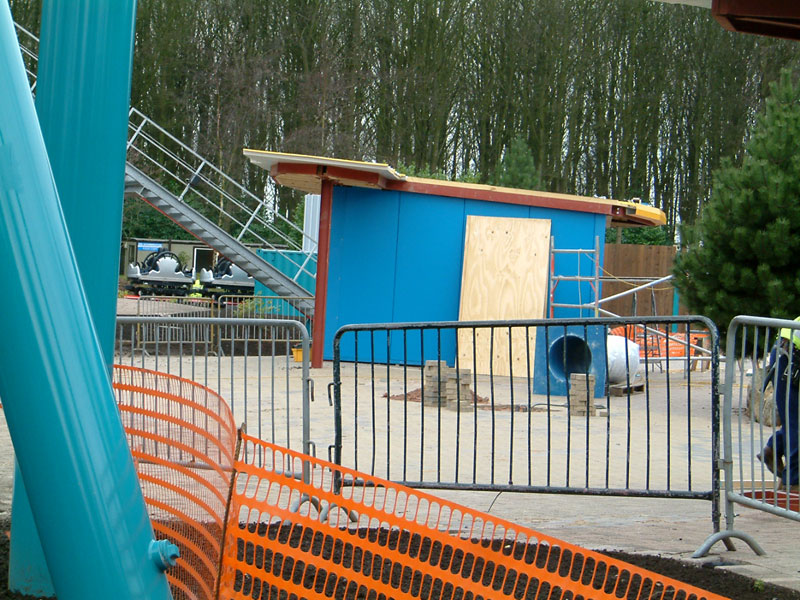

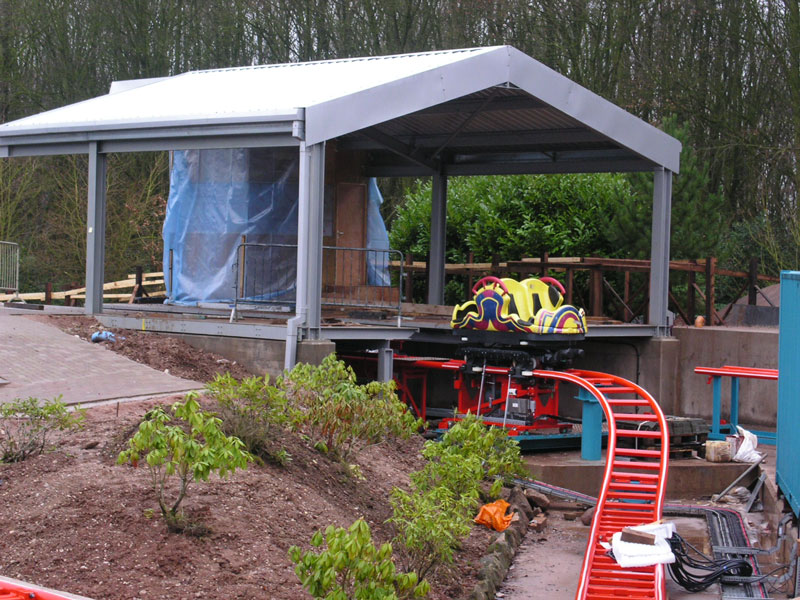

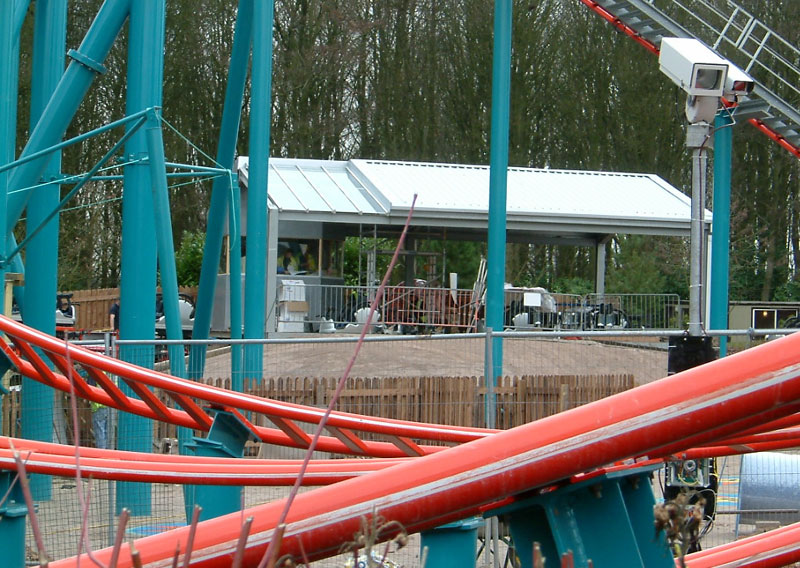

Construction for Spinball Whizzer’s shop has begun.

h

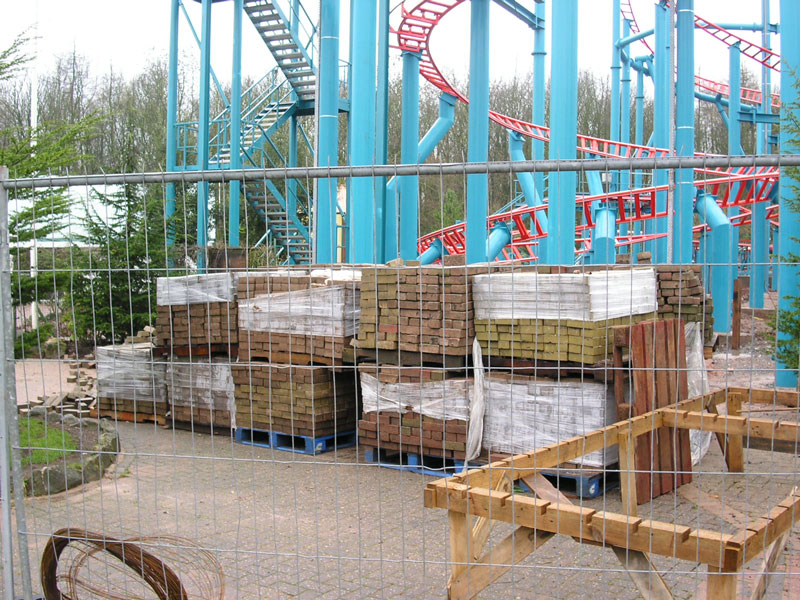

Block paving for the area have arrived.

h

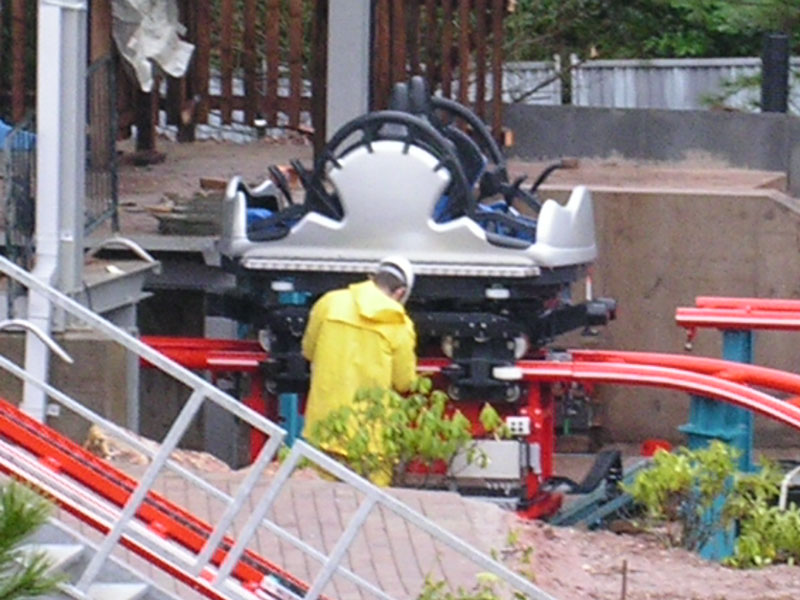

The test car in the station.

h

In this picture its obvious the car has been used lots which suggests it will be used for the purpose of testing only.

h

Here you can see the queue path and the storage track.

h

A close-up of the queue line behind the station.

h

Here we can see the car seats up close.

h

Here we can see the car wheels up close.

h

A Spinball car finally on the track.

h

Testing was in progress today.

h

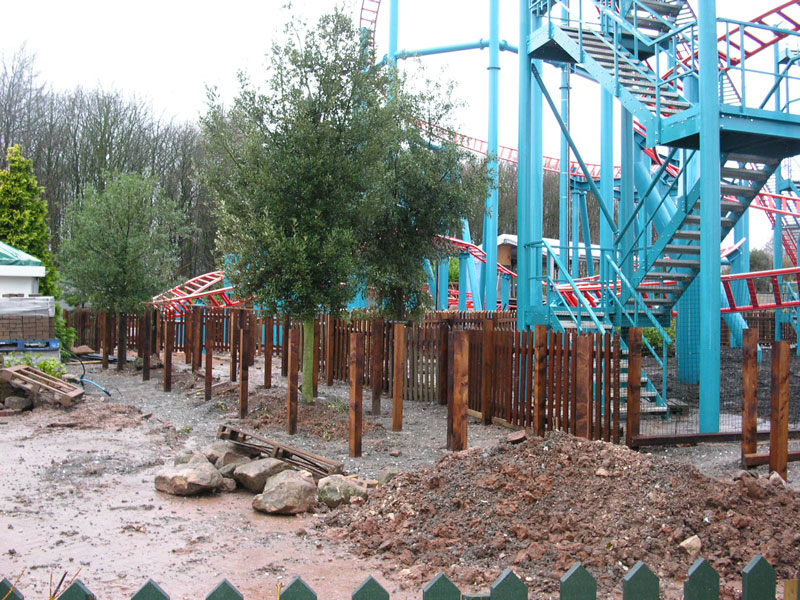

The queue paths.

h

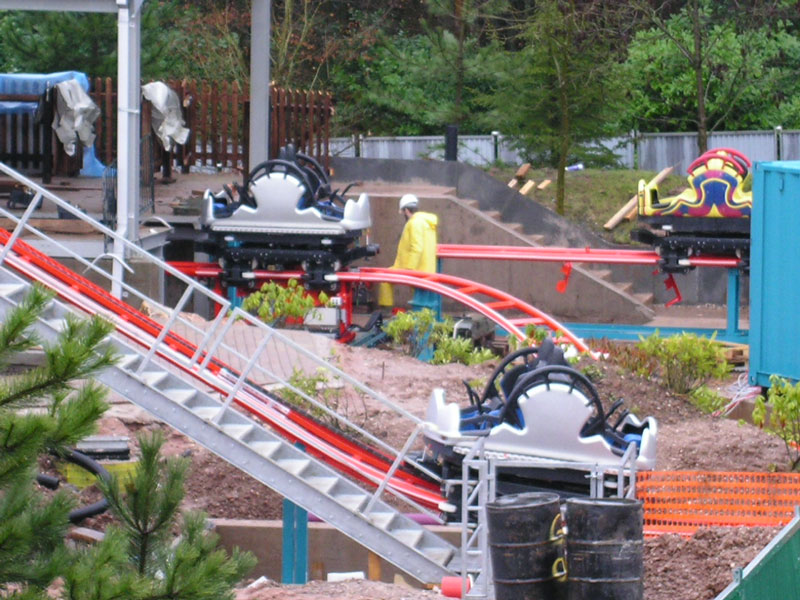

Two spinball cars are now on track.

h

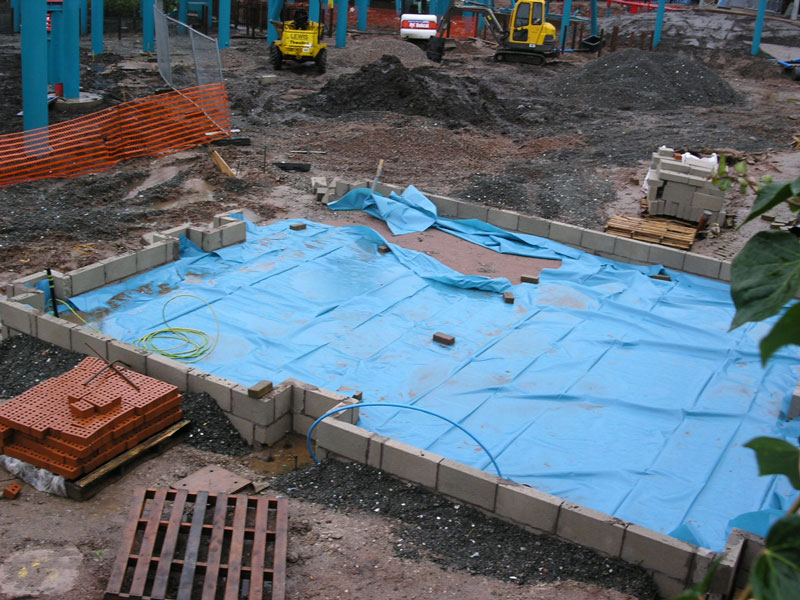

Here we can see the photo shop foundations.

h

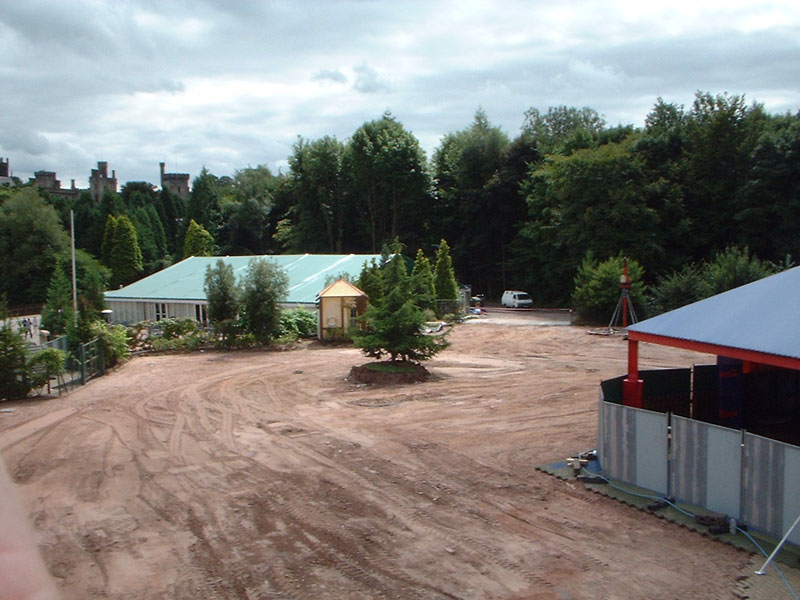

An overview of the site.

h

A view from the Immelmann.

h

Spinball is looking complete from this distance.

h

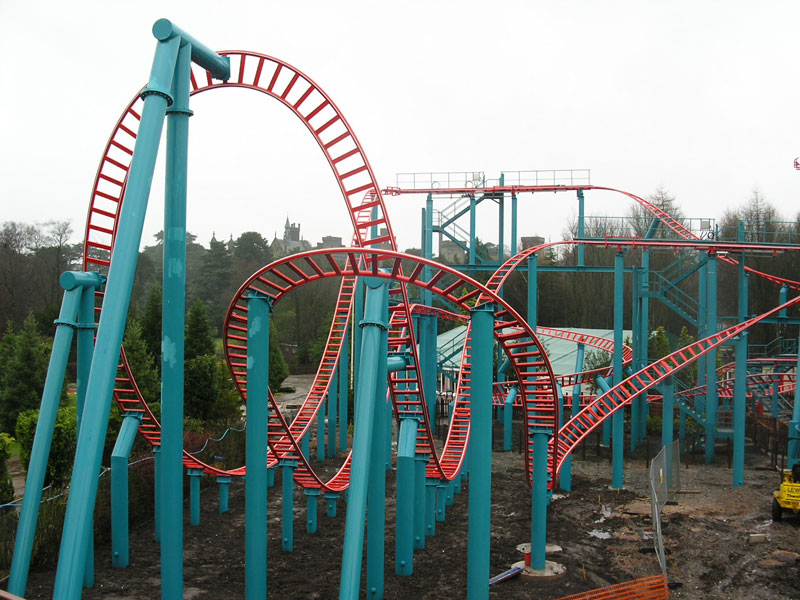

Another view showing off the impressive Immelmann.

h

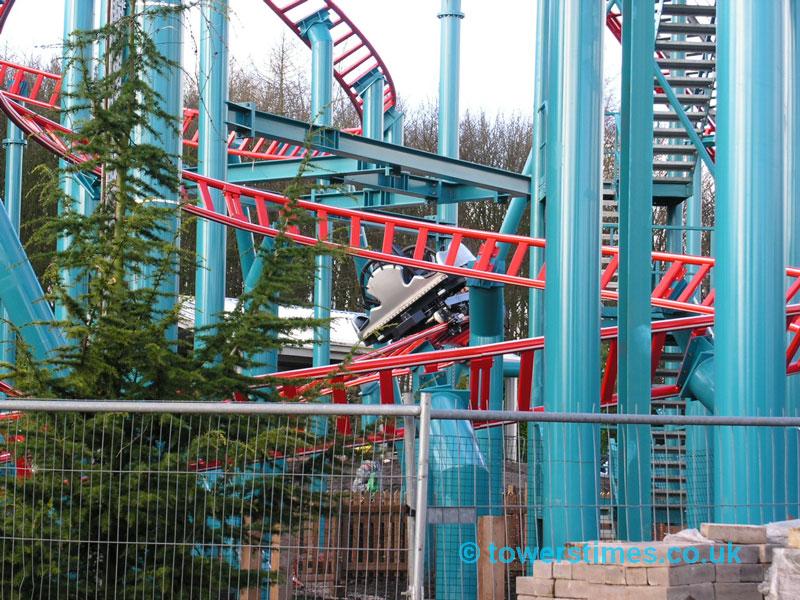

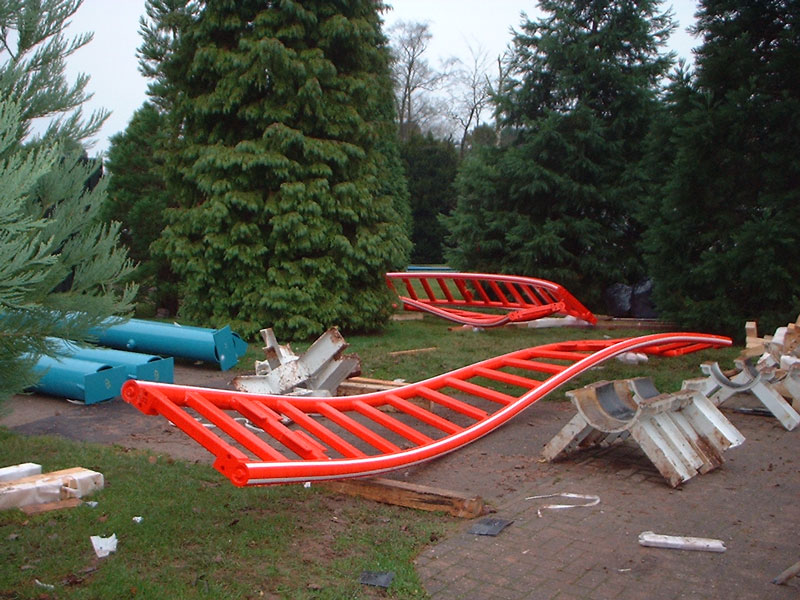

On a test run, one of the cars valleyed!

Six cars on track

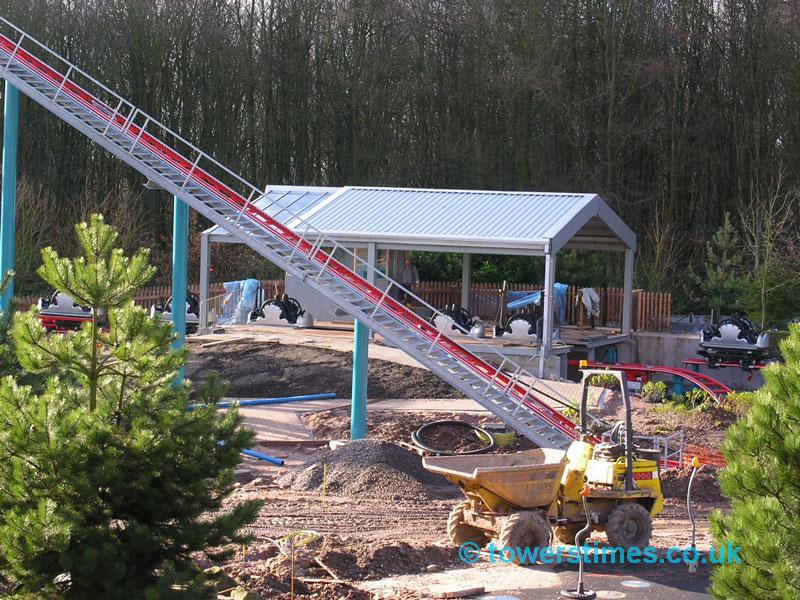

Six cars now on the track!

h

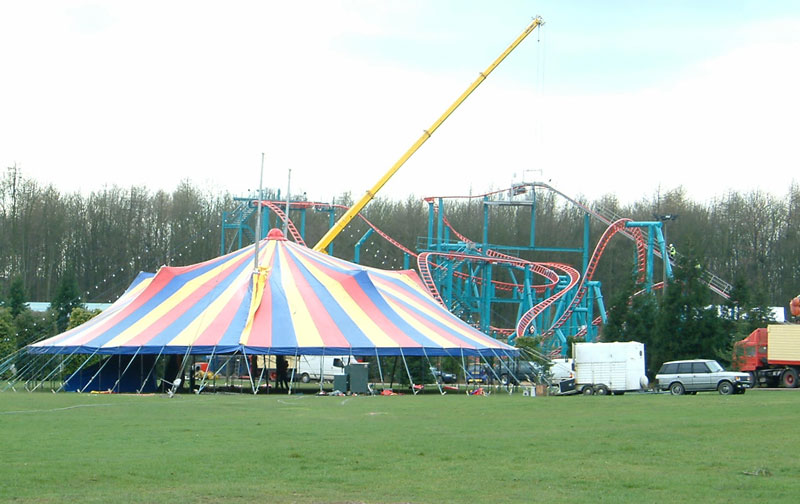

A marquee tent, which looks fairly temporary, has popped up.

h

Here you can see both cameras which will take a photo of each side of the car.

h

Pathway bricks still being laid.

h

A close up of the photo shop.

h

Another building features in this shot, as well as the photo shop.

h

Here we can see all the cars in the nearly complete station.

h

In this photo you can see some theming painted on the floor.

h

Here we can see the area being landscaped.
